The following documents and drawings are included in this manual to provide the necessary information
required for routine operation and fault diagnosis of the system:
This section contains important instructions that must be followed during the installation and maintenance of the
equipment and batteries. Read all of the instructions before operating the equipment, and save this manual for
future reference.
All electrical connections must be performed by licensed electricians only. Installation of the power supply and
batteries must be performed by, or under the direct supervision of, service personnel knowledgeable of the required
electrical and battery safety procedures.
If instructions in this manual conflict with the local electrical codes, follow the local codes.
The following safety symbols are found throughout this manual. Carefully read all information and abide by the
instructions:
DANGEROUS VOLTAGE
This symbol indicates a dangerous voltage
exists in this area of the product.
GAS HAZARD
This symbol indicates a gas hazard
exists in the area of vented batteries.
NO MATCHES OR OPEN FLAMES
This symbol indicates a fire or explosive hazard
exists in the area of the product.
The following warning levels are used in conjunction with the symbols:
DANGER: You WILL be KILLED or SERIOUSLY INJURED if instructions are not followed closely.
WARNING: You CAN be KILLED or SERIOUSLY INJURED if instructions are not followed closely.
CAUTION: You CAN be INJURED or equipment can be DAMAGED if instructions are not followed closely.
Mechanical safety
Keep hands and tools clear of fans. Fans are thermostatically controlled and switch on automatically.
Power supplies can reach extreme temperatures under load.
Use caution around sheet metal components and sharp edges.
Page 5
Electrical safety
WARNING: Hazardous voltages are present at the input of power systems. The DC output from
rectifiers and batteries, though not dangerous in voltage, has a high short-circuit current capacity
that may cause severe burns and electrical arcing.
Before working with any live battery or power system, follow these precautions:
Remove all metallic jewelry, such as watches, rings, metal rimmed glasses, or necklaces.
Wear safety glasses with side shields at all times during installation.
Use OSHA approved insulated hand tools.
DANGER: Lethal voltages are present within a power system. Always assume that an electrical
connection or conductor is energized. Check the circuit with a voltmeter with respect to the
grounded portion of the enclosure (both AC and DC) before performing any installation or removal
procedure.
Do not work alone under hazardous conditions.
A licensed electrician is required to install permanently wired equipment. Input voltages can range up to
240 Vac. Ensure that the utility power is disconnected and locked out performing any installation or
removal procedure.
Ensure that no liquids or wet clothes come into contact with internal components.
Hazardous electrically live parts inside this unit are energized from the batteries even when the AC input power is
disconnected.
Battery safety
Servicing and connection of batteries must be performed by, or under the direct supervision of, personnel
knowledgeable of batteries and the required safety precautions.
Always wear eye protection, rubber gloves, and a protective vest when working near batteries. Remove all metallic
objects from your hands and neck.
Use OSHA approved insulated hand tools. Do not rest tools on top of batteries.
Batteries contain or emit chemicals known to cause cancer and birth defects or other reproductive harm. Battery
post terminals and related accessories contain lead and lead compounds. Wash your hands after handling
batteries.
WARNING: Follow battery manufacturer’s safety recommendations when working around battery
systems.
WARNING: Do not smoke or introduce an open flame when batteries (especially vented batteries)
are charging. Batteries vent hydrogen gas when charging, which creates an explosion hazard.
Batteries are hazardous to the environment and should be disposed of safely at a recycling facility. Consult the
battery manufacturer for recommended local authorized recyclers.
Post installation weather proofing
After installing the conduits and removing any knockouts to accommodate conduit locations, ensure that any gaps
between the conduit fittings and the shroud are sealed. Apply a weatherproof caulking to gaps to prevent wind
driven rain from reaching the electrical equipment.
Figure 34 – Slide cover up and off................................................................................................. 37
Figure 35 – Filter is located inside cover ....................................................................................... 37
Page 10
1 Introduction
1.1 Scope of manual
This instruction manual covers the features, installation, startup, and maintenance of the Alpha Technologies’
Tempest Te45 Outdoor Auxiliary Enclosure.
Enclosure specifications are found in Alpha document #029-039-B2.
Operation instructions for the system controller and related modules are provided in separate component
manuals.
Separate manuals are provided for batteries and other accessory equipment, such as HVAC.
Images contained in this document are for illustrative purposes only and may not exactly match your unit.
Page 11
Figure 2 – Tempest outdoor
auxiliary enclosure. Front view.
AC Load center
Generator connector
Removable rear panels (3)
EVS intake
4000 btu air
conditioner w/ heater
EVS exhaust
Figure 1 – Tempest outdoor auxiliary
enclosure. Rear view.
2 Product overview
The Te45 Outdoor Auxiliary Enclosure is a 72" tall enclosure that can be configured for power, battery or auxiliary
applications. Each configuration is designated by a part number that may include separate available options.
A Te45 system typically includes:
Zone 4 seismic enclosure
Optional AC distribution or junction box
DC power components
Alarm interface
4000 BTU air conditioner and EVS
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 2 of 38
Page 12
EVS intake fans
Air Conditioner
return air
Wind latch
DC light
Air conditione/
heater temp
set point
Air conditioner
supply air
Alarm connection
blocks
High/low temp alarms
GFCI plug in
Ground bar
Cordex
power and
distribution
system
(typical)
Battery
retaining
bracket
Battery
shelves
EVS exhaust
Figure 3 – Typical Te45 enclosure power configuration
Door intrusion alarm
2.1 Typical power configuration
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 3 of 38
Page 13
Ground bar
GFCI outlet
Alarm
termination
blocks
Hi/low temp
alarms
Battery termination bus bars
Battery retaining
bracket
Battery trays
Figure 4 – Typical Te45 Battery Configuration
2.2 Typical battery configuration
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 4 of 38
Page 14
EVS thermostat
Threepoint door
latch
HVAC intake
and exhaust
HVAC controls
Figure 5 – Miscellaneous enclosure features
2.3 Air conditioning and heating
A 4000 BTU air conditioner/500 watt heater package provides cooling or heating to the batteries. It is mounted on
the front door of the enclosure. Refer to the HVAC manual that is supplied with the unit.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 5 of 38
Page 15
Figure 6 – Surge suppression mounted on rear of fibre slack box bracket
2.4 AC panel board and generator connector
The AC panel board and generator connector are supplied by Intersect Corporation. The panel includes an
automatic transfer switch, an additional emergency generator connection, and a manual transfer switch. Refer to
the Intersect manual that is supplied with the unit.
2.5 Equipment mounting rails
4 x 23" mounting rails are installed in the enclosure.
2.6 Battery trays and battery retaining brackets
Two battery trays are provided. Battery retaining brackets are supplied for mounting positions both in front and on
top of the batteries.
Battery trays and retaining brackets are designed specifically for GNB155 batteries. Any deviation from this battery
may affect Zone 4 seismic compliance. Call Alpha before changing battery models.
2.7 T1 surge suppression
The enclosure is provided with a rail mounted bracket that accommodates a fiber slack box and two AC data Model
MPM6-TTTTEE-DL “Multi-port Max 6" surge suppression devices.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 6 of 38
Page 16
Figure 8 – Fiber cable slack box
Figure 7 – Fiber slack box mounted on rear rails
Fiber cable
slack box
2.8 Fiber cable slack box
A fiber cable slack box is provided on the enclosure.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 7 of 38
Page 17

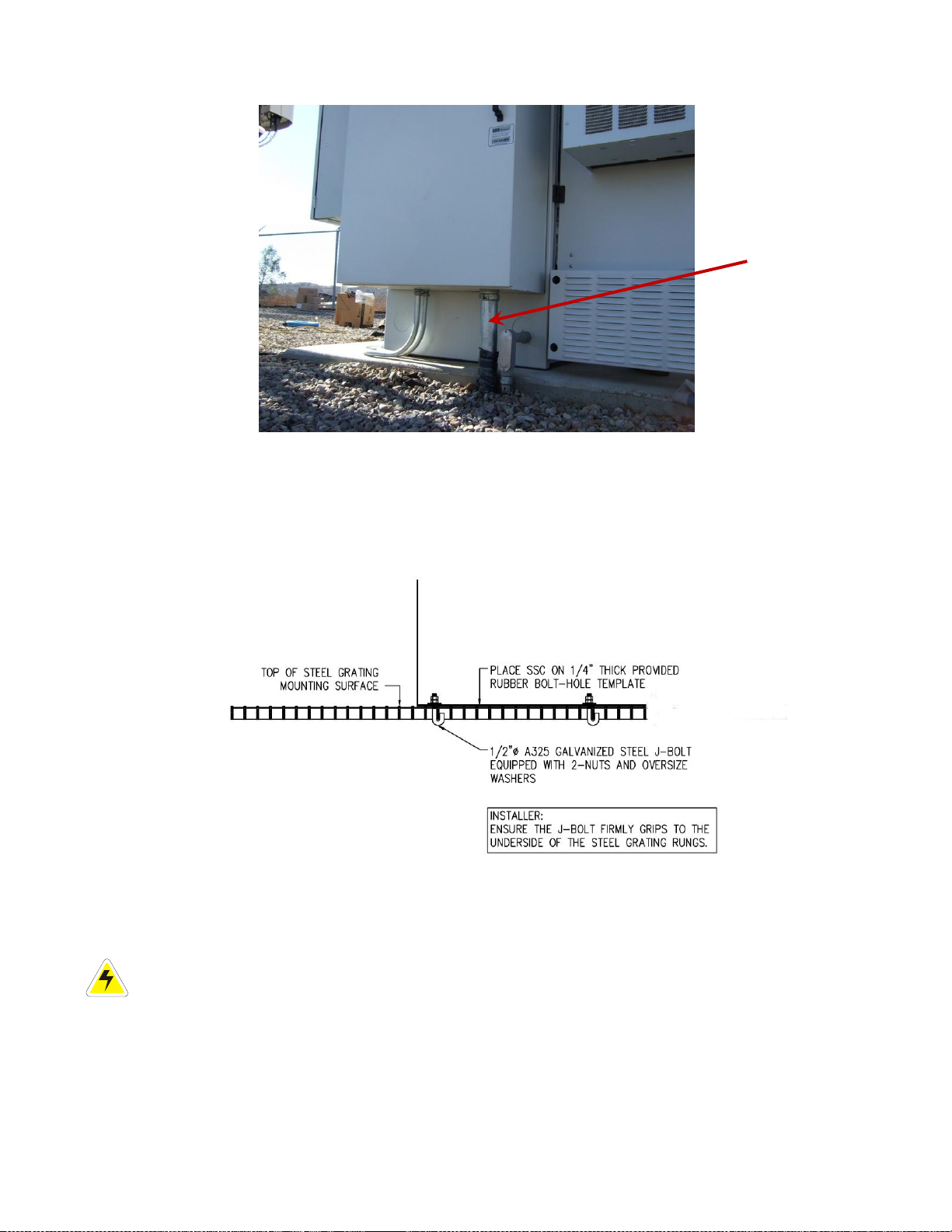

The front door
can be secured
at the handle
via a padlock
Figure 9 – Locking front door
Door mounted
EVS thermostat
2.9 Emergency ventilation system (EVS)
The EVS unit provides ambient cooling when the inside temperature exceeds a predetermined temperature setting
on the EVS control thermostat.
The EVS is a DC system that operates when any one or more of the following conditions is present:
AC power failure. The air conditioner shuts down.
Air conditioner compressor failure.
Extreme ambient temperatures above 45°C.
2.10 Doors and access panels
The hinged front door is held closed by a 3 position latching system with a pad lockable handle.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 8 of 38
Page 18
Remove rear top panel
CAUTION:
The rear panels are
connected by a
ground strap and
release cable, but can
fall upon release.
Pull on handle to
release top rear panel
Remove each set of wing
nuts, one on each side, to
release the lower panel.
To remove rear
panel, disconnect
lanyard and ground
strap once the panel
is released

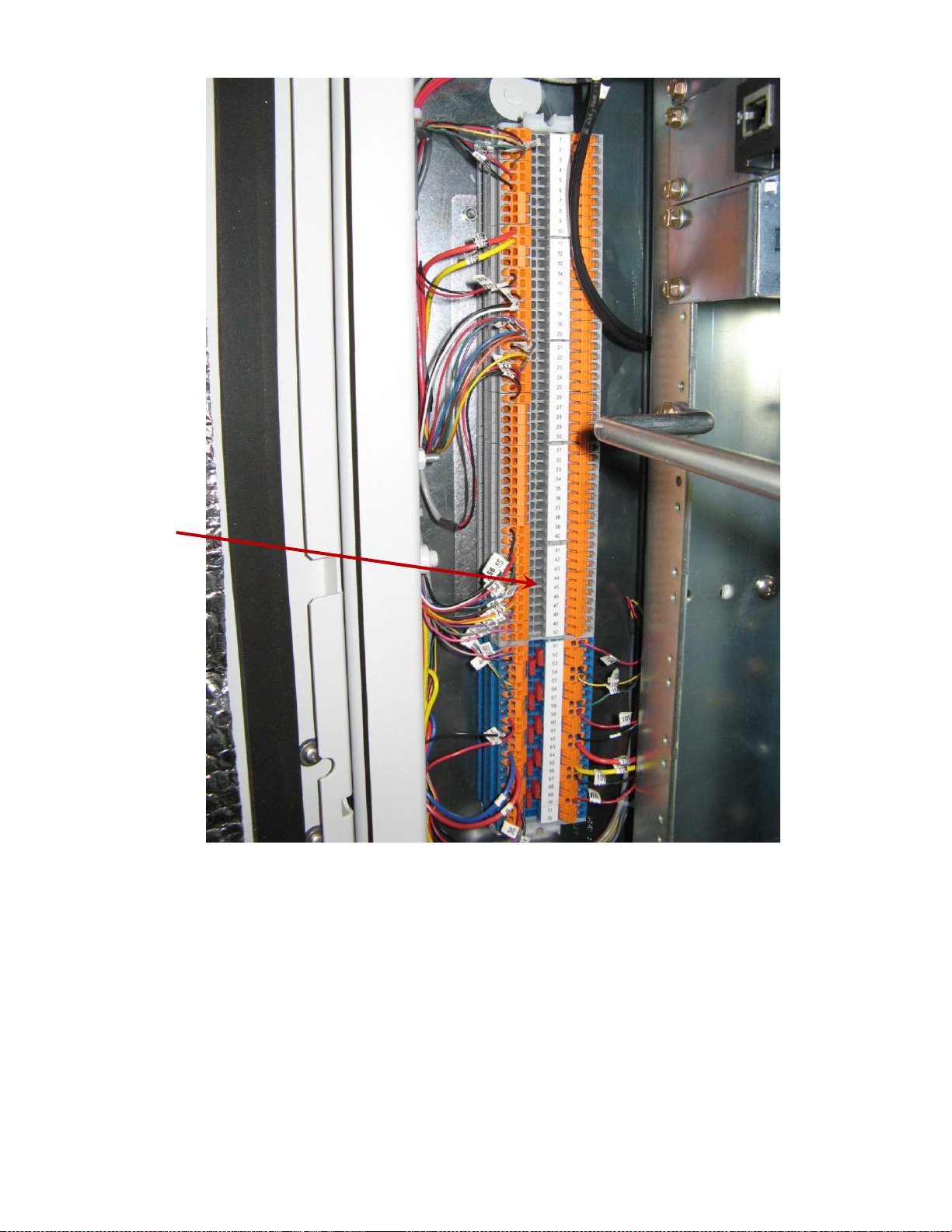

Figure 10 – Rear panel latch
Figure 11 – Rear panel released
Figure 12 – Wing nuts retaining lower panels
Figure 13 – Disconnect lanyard and ground strap
When installing the rear panels,
first install the lower panel, and
then install the middle panel.
When installing either panel, first
connect the ground strap, then
move the panel into place, and
finally tighten the wing nuts
securely.
On the upper panel, re-install the
ground strap and re-attach the
lanyard as shown
2.11 Rear access panel
There are three rear access panels. The top panel is a slam latch panel. The lower two panels use internal wingstuds that must be removed to lift off the panels. The following procedure explains how to remove the rear panels:
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 9 of 38
Page 19
Remove eyebolts
Remove solar shield to
expose hatch plate
To release hatch plate, pull the
latch ring toward the rear of the
enclosure in the direction shown
by the large arrow
2.12 Removable solar shield and hatch plate
To re-install, ensure the slam latch on the hatch plate is fully engaged.
Re-install the solar shield by re-installing the eyebolts.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 10 of 38
Page 20
Distribution
center
Rectifier
2.13 DC power equipment
2.13.1 Distribution panel
The DCP03, 300 A distribution center in an integrated DC system distribution package designed for small to
mid size power applications.
The distribution panel takes up three rack units of space.
The DC system and signal connections are accessible from the front of the panel.
All distribution wires are connected via two-hole termination lugs.
Up to 18 plug-in breakers can be installed at up to 100 A per position. Optional multiple pole breaker adapter
kits are available.
The 4R/8D ADIO Cordex peripheral is installed in the front door, expanding the I/O capability of the controller.
2.14 Rectifier and shelf
37.5 A @ 48 Vdc is provided to each rectifier.
Rectifiers are hot swappable.
2RU ultra compact rectifier design.
The fan cooled 1.8 kW rectifier has extremely high density with a compact 2RU design that allows five rectifiers per
23" shelf and four rectifiers per 19" shelf together with an integrated CXCI controller. An optional CXCM2 controller
with a touch screen display is available.
Local and remote setup, adjustments, and control are a single step process via the controller. By using TCP/IP
technology, complete configuration and monitoring of power equipment can be done through a network web
browser.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 11 of 38
Page 21
CXCI Cordex
controller
GMT fuse block
mounted to side
of distribution
center
2.15 Controller
The compact CXCI Cordex controller is an integrated option that fits inside the rectifier shelves and takes up 2RU
of space. The controller includes a complete range of standard software features.
The controller includes a web server interface that provides easy set ups via local or remote IP access using a
standard Internet Explorer browser. The controller features LED indicator lights and an LCD screen that displays
voltage and current.
An integrated logging feature is typically available only with an advanced, standalone, data logging system. It
allows the capture of data from multiple AC/DC voltages, load/battery currents, and cell voltages/temperatures.
Common applications of the logging include power system details, thermal performance of outdoor enclosures,
battery cell specifics, and mains variations captured by an AC voltage watchdog.
The CXCI I/O features can be expanded by adding CXC smart peripherals, such as battery cell monitoring, shunt
multiplexing, or alarm relay expansion.
Cordex CXC controllers are designed to ensure effortless operation of Cordex rectifiers. Otherwise complicated and
time consuming set ups are greatly simplified.
2.15.1 GMT fuse block
An 8-position GMT fuse block is installed in the enclosure to provide additional distribution capability.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 12 of 38
Page 22
3 Transportation and storage
3.1 Packaging
The enclosure and components are shipped on individual pallets and shrink wrapped. The enclosures and
components must not be stacked. Packaging assemblies and methods are tested to International Safe Transit
Association standards.
The pallet is approximately 0.15 m H x 1.22 m W x 1.22 m D (6" H x 48" W x 48" D) and the overall height including
pallet and enclosure is approximately 1.98 m (78").
Batteries are shipped on a separate pallet and packaged according to the manufacturer’s guidelines. Packaging
assemblies and methods have been tested to International Safe Transit Association standards.
3.2 Storage
The weight of the enclosure is written in the specifications. The equipment pallet can be moved using a forklift.
Do not hoist/lift the enclosure with batteries installed.
The warehouse facility may need to be certified for handling the batteries, which are shipped on a separate pallet.
3.3 Inspection
Before unpacking the equipment, perform a visual inspection and note any damage. Unpack the equipment and
inspect the exterior for damage. Contact the carrier immediately if any damage is observed.
Continue the inspection for potential internal damage. Contact the carrier immediately if internal damage is
detected. Then contact Alpha Technologies for advice on the consequence of any damage.
Verify that you have all the required parts before proceeding with the installation.
Call Alpha Technologies if you have any questions: 1-888-462-7487
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 13 of 38
Page 23
4 Installation
4.1 Pre-installation considerations
The information in this section is intended to be used as a guideline only. There may be site-specific requirements
and other factors that may require different procedures. For example, your jurisdictional codes and construction
covenants may require different procedures than those in this manual.
4.2 Power system
An Alpha system provides sufficient power for a defined frame load plus the capacity to recharge the batteries
within 24 hours.
“N+1 recharge” time refers to the estimated hours to recharge the batteries to 95% while operating at full load with
all the rectifiers working and where a “redundant” rectifier is installed. Consult the factory if your equipment
configuration has changed from its original layout.
4.3 HVAC system
The 4000 BTU air conditioning/heater and the emergency ventilation system are optimized and tested for a
particular equipment configuration within the enclosure. Consult the factory if your equipment configuration has
changed from the original layout. Factory testing may be required for new equipment configurations.
4.4 Site selection
The Te45 has been designed as an outdoor power system enclosure. The most common mounting structures are:
An at-grade concrete slab.
A steel platform.
An existing structure, such as a rooftop.
The mounting structure must be strong enough to support a fully equipped enclosure. Existing structures may need
to be reinforced to support the enclosure. The mounting site must be built in accordance with local building
practices and codes. A fully equipped power enclosure with 5 rectifiers and 8 batteries weighs approximately 2000
lb. A fully configured power enclosure with 16 batteries weighs approximately 3000 lb.
Consider the following before selecting a mounting site:
The Alpha Te45 enclosure is designed for front, rear, and if necessary top access. Only front access is required
for maintenance.
Avoid areas that may be subjected to hot air exhaust from nearby equipment or buildings.
Find out if your intended area is subjected to architectural controls or environmental restrictions.
Avoid areas that are prone to flooding.
4.5 Enclosure support
A supporting structure with a minimum load capacity of 350 lb/ft² is required to support a fully equipped power
enclosure with rectifiers, batteries, air conditioner, etc.
A support structure with a minimum load capacity of 500 lb/ft² is required to support a fully equipped battery
enclosure.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 14 of 38
Page 24
Figure 14 – Base layout drawing and mounting hole locations
4.5.1 Base layout dimensions
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 15 of 38
Page 25
Figure 15 – Concrete anchor bolt fastening detail
4.5.2 Concrete slab
Cast-in-place or pre-cast concrete slabs can be used.
Place the enclosure on the concrete slab. Use the enclosed Hilti HSL heavy-duty expansion anchor bolts, or
approved equivalents, and the enclosed square seismic washers to secure the enclosure. Follow the specific
recommendations from the fastener manufacturer to ensure that the securing device achieves its full structural
capacity. Take into account the embedment depth and the clear edge distances. Refer to the following figure.
Alternate mounting systems that are not provided directly with the enclosure must be reviewed by a registered
professional engineer that is qualified to practice within the jurisdiction where the enclosure is being installed.
An alternate mounting system could for example use a chemical anchoring system such as Hilti’s HY150 for
concrete or HY20 for masonry along with suitable threaded rods and inserts from the manufacturer. Follow the
manufacturer’s recommendations to determine the spacing and placement of the threaded rods.
The structure must be designed to support a fully equipped enclosure. The concrete slab and any existing
structures must be properly reinforced to support the floor loading. The mounting site must be designed and
installed in accordance with local building practices and codes.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 16 of 38
Page 26
Figure 17 – Installation on steel platform
Figure 16 – AC conduit outside concrete slab
AC conduit
located outside
cement pad
4.5.3 AC connections with concrete slab mounting
4.5.4 Steel platform
Use 1.27 cm (½") diameter A325 structural bolts in conjunction with a backing plate/clasp to grip the underside of
the grating. Once the enclosure is in place, secure the bolts on the inside using appropriate washers and bolts. See
the following figure:
CAUTION: Installation on a wood base is not recommended. The compressive strength of the base
material would not be able to maintain the load during a Type 4 seismic event.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 17 of 38
Page 27
Figure 18 – Multiple enclosure installation
4.6 Multiple enclosure installations
For multiple enclosure installations, a kit is required that includes gaskets and cable components. See Drawing
747-670-08 for complete instructions.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 18 of 38
Page 28
Roxtec seal port 9 way assembly including
boot, mounting collar and hardware
Alpha part number: 037-193-20-000
Can be used for cable entry into the Te45 enclosure wherever there are 3" knockouts.
See www.roxtec.com for
additional information
4.7 Installation component requirements
Concrete and metal grating mounting hardware is not supplied with the enclosure.
AC electrical conduit, cable and fittings are not supplied with the enclosure.
Internal DC cables are supplied. External DC conduit, cable and fittings are not supplied with the enclosure.
A cable entry port fitting is available as an option:
For multiple enclosure installations, an interface kit is required.
Power to battery: 747-602-20
Battery to battery: Currently not available
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 19 of 38
Page 29
Figure 19 – Example of an insulated tool kit
4.8 Installation tools and equipment
4.8.1 Tools Required
Insulated tools are essential for DC power system installation. Use this list as a guide:
Electric drill with hammer action
Digital voltmeter equipped with test leads
Lap top computer with Cordex communication software (not required for initial installation and test)
Various crimping tools and dies, to match lugs used in installation
Torque wrench: ¼" drive, 0-150 in-lb for battery post connections
Torque wrench: 3/8" drive, 0-100 ft-lb for system connections
Insulating canvases as required (2' x 2', 1' x 1', 3' x 3', etc.)
Insulated hand tools:
-Combination wrenches -Ratchet and socket set
-Various screwdrivers -Electricians knife
-Fine tipped slot screwdrivers (“tweaker”)-Cable cutters
Cutters and wire strippers (#14 to #22 AWG) [2.5 – 34 mm2].
4.8.2 Lifting equipment requirements
Hoist or crane capable of lifting 1814 kg (4000 lb)
The forklift should have a rated lifting capacity of 1814 kg (4000 lb) with a minimum fork length of 36"
Four wire-rope slings at least 1.22 m (4') long with a capacity of 907 kg (2000 lb) each.
Four clevises.
One minimum 1.59 cm (5/8") diameter rope to use as a tagline to guide the enclosure while lifting.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 20 of 38
Page 30
Figure 20 – Secure hooks in eyebolts
4.9 Enclosure installation
4.9.1 Enclosure preparation
Remove the protective covering from the system. The doors are designed to be locked with a pad-lock and are
secured with tie-wraps for shipping. Cut the tie-wraps and open the doors. The inside of the enclosure contains the
rectifiers, and other hardware.
Inspect the packing slip to verify that you have received all the equipment that you ordered.
If the batteries are on a separate pallet, do not install them until after the enclosure has been secured and the
ground wires and other cable entries are connected. It is easier to route the cables when the batteries are not
installed.
All documentation is packed inside the equipment compartment.
Inspect all moving parts, hardware, connectors, and other equipment.
Report any damage to the shipper and Alpha Technologies.
Remove and properly dispose of all packaging.
Save the rectifier boxes for future transport.
Remove the rear panels to access the rear mounting bolts.
Remove the four bolts that secure the enclosure to the pallet. These bolts are accessible from the inside of the
enclosure and are located in the corners of the enclosure. The enclosure is now ready for lifting.
4.9.2 Lifting preparation
CAUTION: Follow all local safety practices and guidelines while lifting the enclosure. All personnel
involved with lifting and positioning the enclosure must wear head and eye protection and gloves.
Only properly trained and certified personnel should operate the crane. Only properly trained and
certified personnel should operate the forklift.
Make sure that the lifting eyes are securely fastened before lifting the enclosure. Ensure that the clevises are
correctly installed and that the enclosure is approximately level during the lift. This will simplify the enclosure
positioning.
Close and latch the enclosure front door. The rear panels do not have to be installed.

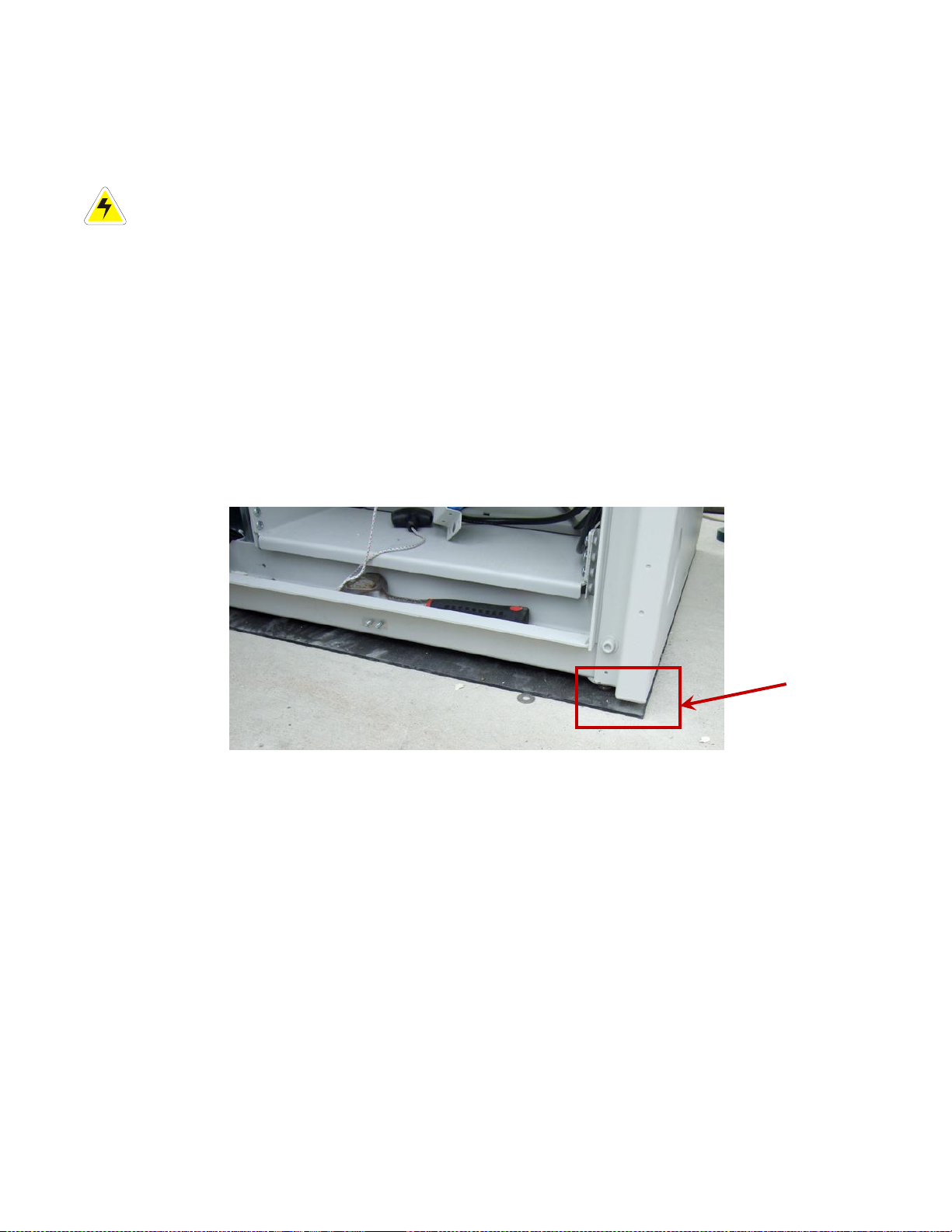

Place the enclosed rubber mat onto the slab or platform. Orient the mat so that the mounting holes line up. If
the rubber mat is “ribbed” the ribs should be against the concrete.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 21 of 38
Page 31
Place shims
close to corners
4.10 Mounting the enclosure
4.10.1 Concrete slab
Use the tagline to guide the enclosure as it is lifted. As the enclosure is lowered, align the mounting bolts and
slowly lower the enclosure into place.
CAUTION: Follow all local safety practices and guidelines while lifting the enclosure. As the
enclosure is lowered, ensure that it remains as level as possible and lines up with the anchoring
bolt locations. Ensure the rubber mat is in the proper position. Open the door and proceed with
leveling the enclosure and securing it into place.
Leveling the enclosure
Four 0.125" shims are provided with the enclosure. Before securing the enclosure, make sure that it is level.
Place the shims as close as possible to the bolts.
Check that the enclosure is level font-to-back and side-to-side.
A shim may need to be added under one or two of the corners of the enclosure. To place a shim, take just
enough weight off the enclosure to slide the shim into place.
Allow the full weight of the enclosure to rest on the shims, and then check the level again.
Once the enclosure is level, tighten all bolts to the appropriate torque. After securing the enclosure, remove the
slings and lifting eyes.
4.10.2 Steel platform
If the steel platform is located at ground level, the procedures are the same as those for a concrete slab.
4.10.3 Roof mounting
CAUTION: The mounting platform must be installed before the enclosure can be installed. All grounding
must be in place before the installation.
Place the enclosure onto the roof using either a freight elevator with access to the roof, or by using a crane or
Do not remove the enclosure from its pallet until it is on the roof and is ready to be positioned.
If two or more enclosures are to be installed adjacent to one another, install the environmental components of
For detailed procedure, refer to the next chapter and drawings 747-602-08, 747-603-08, or 747-607-08.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 22 of 38
hoist on the roof.
the interface kit before bolting the enclosures into place.
Page 32
External chassis ground
connected to site ground.
There are two connection
points, one at the front of
the enclosure, and one at
the rear. Only one
connection is required
with an exothermic
connection.
Ground wire that
connects the site ground
to the master ground bar
Figure 21– Enclosure
ground connections
Ground studs
MG
4.11 Grounding
DANGER: An enclosure that is not properly grounded presents an electrical hazard.
A proper grounding system that meets or exceeds the specifications of the equipment must be designed and
installed prior to or in conjunction with the construction of the mounting pad. The ground system must be bonded to
the enclosure to ensure a “common” or “single-point” ground.
Examples of grounds:
New builds – a buried ground ring with a bare, solid conductor going to ground rods.
Rooftop – a connection to the building’s steel structure, water pipes, etc.
Refer to local codes and practices for proper acceptable grounding arrangements. Only a licensed electrician
should be used to install the grounding system. Use a dedicated ground rod for the AC panel.
CAUTION: Do not route AC and DC wiring in the same conduit.
4.11.1 Site ground wire entry
External ground studs are located at the bottom front and rear of the
enclosure. Use these for the site ground wire connections. Terminate
either the front or rear connection to the external ground ring with an
exothermic connection. A minimum of #2 AWG solid wire is required.
4.11.2 Master ground bus (MGB)
The master (main) ground bus is located at the lower left front corner
of the enclosure. Terminate the MGB to the external ground ring with an exothermic connection. A minimum of #2
AWG solid wire is required.
4.11.3 Enclosure chassis ground
The enclosure chassis ground is pre-installed at the factory. It is connected to the enclosure frame and equipment
racks and is terminated to the MGB inside the enclosure.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 23 of 38
Page 33

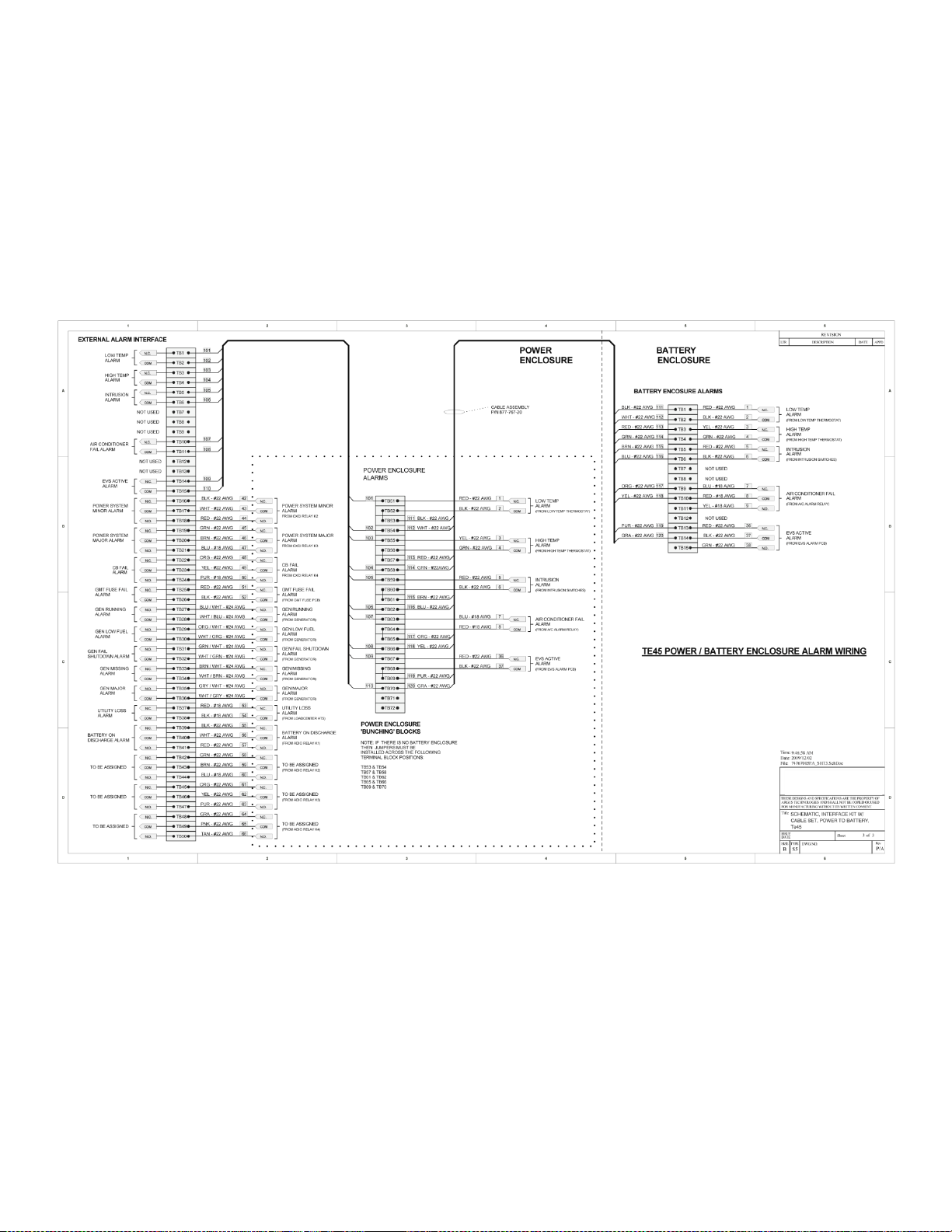

Figure 22 – Alarm connections
4.12 Wiring, cable management, and connections
This section explains how to install and interconnect the power components within the enclosure. For battery
installation, refer primarily to the manufacturer’s manuals.
Ensure the cables are not routed against any unprotected steel edges.
The cables must be neatly tie-wrapped or contained within a plastic loom.
Run the DC, ground, AC, and data cables in separate conduits.
4.12.1 Alarm connections
Route the alarm cable through the bridge interface to the adjacent enclosure. See the enclosed schematic for alarm
connection details. If necessary, configuration changes can be made at the alarm wiring terminal block.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 24 of 38
Page 34
Figure 23 – Alarm block
Alarm block
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 25 of 38
Page 35
Figure 24 – Slab AC conduit installation
Figure 25 – Underground AC conduit installation.
AC panel extends of edge of concrete slab
4.13 Utility connections
Different sites require different methods of conduit installations.
4.13.1 AC conduit installations
Verify local and national electrical codes prior to the installation. The codes may vary and contain specific
conduit and wire sizes for the panel board connection.
The connection to the utility power must be approved by the local utility before the power supply can be
connected.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 26 of 38
Page 36
Figure 26 – DC and fibre cable routing at top of enclosure
Figure 27 – DC and fibre cable routing at bottom of enclosure
4.13.2 Procedure
1. Ensure that all AC breakers are in the off position at the AC source and within the AC panel.
2. To access the interior assembly, open the AC panel door and remove the cover.
3. Use the knockouts supplied on the AC enclosure for the cable routing.
4. Install the conduit nipple into the service entrance opening. Secure the nipple into place using the appropriate
locking nut(s) and sealing washer(s).
5. Review the AC panel documentation and then connect the AC cables.
6. Measure and record all voltages before switching on the main breaker. Do not switch on individual breakers.
7. If required, notify the local electrical inspector to approve the AC input wiring.
4.14 Other cable connections
Holes must not be drilled into the enclosure other than at conduit knockouts.
All cable entry fittings must be water tight.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 27 of 38
Page 37
Figure 28 – Fiber optic cables must be protected by a loom at the cable entry
4.15 Internal cable routing
Keep internal cable routing neat and secured with tie wraps.
Ensure that fiber optic cables do not make sharp bends and are protected by a flexible conduit. A split loom
with a length of 28' and a diameter of 1" is supplied with the enclosure. It is used to for the top and bottom fiber
optics cable installations.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 28 of 38
Page 38
Install gaskets at
the front and rear
of each of 3 of 4
batteries.
Figure 29 – Gasket installation on batteries
4.16 Battery installation
WARNING: Follow the battery manufacturer’s safety recommendations when working around
battery systems and review the safety instructions provided in this manual.
4.16.1 Preparation/mounting
Make sure the enclosure is properly mounted and secured before starting the battery installation.
The batteries should be located in a temperature-controlled environment (Tempest). Regulate the temperature
to approximately 25°C (77°F). Significantly lower temperatures reduce the battery performance and higher
temperatures decrease the battery life.
Clean the batteries cells according to the battery manufacturer's recommendations. First neutralize any acid
with a baking soda and water solution, rinse the batteries with clean water, and then wipe them dry.
Install gaskets at the front and rear of each 3 of 4 batteries.
4.16.2 Battery installation in Alpha Tempest power systems
Verify that all battery breakers, DC circuit breakers, and fuses on the distribution panels are either
in the OFF position or removed. For each of the following steps, verify that the rubber terminal caps
or plastic covers are installed and completely cover the positive and negative terminal connections.
1. Apply a corrosion-inhibiting agent, such as NO-OX-ID “A”™, on all battery terminal connections.
2. Lift each battery onto the front edge of the shelf, and then slide the battery into the shelf.
3. Ensure that each battery output cable reaches the [+] and [–] terminals of the series battery string. Make sure
that the batteries are oriented for easy installation of the inter-unit “series” connectors.
4. Remove any NO-OX-ID “A”™ grease from the battery terminals.
5. Burnish the terminal posts with a non-metallic brush, polishing pad, or 3M Scotch Brite™ scouring pad.
6. Apply a light coating of NO-OX-ID “A”™ grease to the terminal posts.
7. If lead plated inter-unit connectors are used, they should also be burnished and NO-OX-ID “A”™ grease
applied as above.
8. Install the battery shelf retaining brackets.
9. Install the inter-unit connectors.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 29 of 38
Page 39
Figure 30 – Battery fuse kits and battery cabling. See attached drawing for more details
10. Locate battery string fuse kits and connect the batteries to the pre-installed cables coming from the system DC
output bus bars.
Install all the battery terminations with the correct torque settings. Refer to the above drawing and
the battery manufacturer's manual.
Repeat the above installation procedure for each shelf and battery string.
WARNING: Do not connect the Anderson connectors before reviewing the startup procedures.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 30 of 38
Page 40
5 System startup
After completing the enclosure installation and the power system wiring, perform the following startup and test
procedure:
5.1 Connecting the batteries
1. Check and verify the polarity of all the batteries.
2. Open all the DC breakers and temporarily remove all the DC fuses. The breakers must be closed and the fuses
reinstalled after the testing is complete.
3. Unplug all rectifiers except one.
4. Switch on the AC breakers to apply power to the rectifier shelf.
5. The controller will perform a short self-test as it boots up.
6. Alarm conditions will likely be present and will probably not clear because there is no DC load on the rectifiers
since all the loads are disconnected.
7. The system voltage will be visible on the controller display.
8. With the batteries disconnected, measure the voltage difference between the power system and the battery
string. The voltage difference should be less than 3 V. If the voltage difference is greater than 3 V, check the
cable connections and the conditions of the batteries. Correct the problems and then proceed. If you are unable to correct the problem, switch off the AC input power and contact Alpha Technologies.
9. Measure the battery voltage at the battery connector and ensure that the polarity is correct. Connect the first
string of batteries by plugging in the Anderson connector. Repeat this step for the remaining string of batteries.
10. Plug in the remaining rectifiers one at a time.
11. All the alarms should clear and the audible alarm will switch off provided the batteries are slightly discharged.
12. Switch on the all the remaining breakers. The air conditioner fans should start.
13. Apply the DC loads by switching on the DC powered equipment.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 31 of 38
Page 41
5.2 Test and commissioning overview
5.2.1 System
All power system components undergo thorough factory testing. All levels and alarms are set to values according to
the information given in the component manuals, unless custom levels are specified. Check the operation of all
features and alarms and ensure that the power system levels are set in accordance with the specific requirements
of your system. See the component manuals for more details.
5.2.2 Environmental/intrusion
Check the operation of all enclosure features, such as the air conditioning unit settings, the high/low temperature
alarms and the intrusion alarm.
5.3 Battery
After the batteries have been installed, the batteries must be “initially charged” to eliminate plate sulfation. Follow
the guidelines in the battery manual. Record the initial charge readings, which are: specific gravity, cell voltage,
charge current, and temperature. Battery warranty may be void if the batteries are not initially charged following the
manufacturer's guidelines and proper records maintained.
Some VRLA batteries do not require initial charging if they are placed on charge within 3-6 months of manufacture.
Check the battery manufacturer’s manual.
After the equalization period, reduce the battery voltage to the recommended float level.
Once the batteries have been initially charged, perform a short duration high rate discharge test on the batteries to
verify that the cable connections are good and that there are no open or failed cells. Monitor the cell voltages during
this process:
Discharge for 15 minutes at the C/8 rate.
Record cell voltages every 5 minutes.
Check for overheating connections.
5.3.1 Documentation
Complete all the required commissioning documentation such as:
Battery reports.
DC wiring lists.
AC distribution tables.
Floor plans.
Fill out tag wire identification strips.
Identify circuit breakers.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 32 of 38
The EVS thermostat is programmed with the following factory default setting.
5.6 Enclosure temperature alarms
The enclosure compartment thermostat is programmed with the following default factory settings.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 33 of 38
Page 43
Figure 31 – Completed installation
6 Final cleanup
Vacuum clean all metal filings and other debris from inside and around the enclosure.
Ensure that:
All cables and conduit are neatly secured.
Access panels are installed correctly.
All connections are tight.
All breakers are on and the system is running without any alarms.
Enclosure is locked and secure.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 34 of 38
Page 44
Description
Interval
Clean ventilation openings
1-6 months
Test and calibrate controller and other control circuits
1 year
Inspect all cable connections, re-torque if necessary
1 year
Verify alarm/control settings
1 year
Verify alarm relay operation
1 year
Check batteries
6 months
Clean HVAC filter
2-6 months
7 Maintenance
The equipment requires regular maintenance. The maintenance should be done by qualified service personnel
only.
WARNING: HIGH VOLTAGE AND SHOCK HAZARD.
Use extreme care when working inside the enclosure/shelf while the system is energized. Do not
make contact with live components or parts. Static electricity may damage circuit boards, including
RAM chips. Always wear a grounded wrist strap when handling or installing circuit boards.
7.1 General maintenance schedule
7.2 Air conditioner
7.2.1 Air conditioner settings
The air conditioner is pre-programmed with default settings at the factory. Refer to the air conditioner manual if
you need to adjust these settings.
The air conditioner is not always thoroughly tested at the factory. If the air conditioner fails to switch on when it
should, refer to the air conditioner manual and check the temperature settings.
If the air conditioner appears to be working properly but the “Hi-Temp” alarm is on, check that the enclosure's
Hi-Temp alarm thermostat is correctly set.
7.2.2 Air conditioner filter
Air conditioners usually fail because of lack of maintenance, specifically dirty filters. Initially this filter must be
checked frequently until a proper maintenance schedule has been developed.
IMPORTANT: Scheduled filter maintenance must be dutifully followed to reduce the chance of air
conditioner failure.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 35 of 38
Page 45
8 Batteries
The following generic maintenance instructions apply to valve regulated lead acid (VRLA) batteries. Each battery
type and manufacturer will have their own unique maintenance instructions, which must take priority over the
generic instructions listed here.
8.1.1 Monthly maintenance
Check and record each individual battery voltage.
Check and record the ambient temperature.
8.1.2 Semi-annual maintenance
Check the voltage of each cell.
Check the total voltage of all cells.
Check the temperature of each cell.
Visually inspect the general appearance and cleanliness of the batteries.
Check for cracks in cells or electrolyte leakage.
Check for corrosion.
Re-torque all intercell connector bolts.
Check the connections resistances cell-to-cell and cell-to-terminal.
Measure the conductance and impedance of each cell.
8.1.3 Performance/ integrity checks
The controller can perform real time monitoring of the performance of each battery. Parameters that can be
monitored include voltage, specific gravity, conductance, and impedance. See the controller manual.
8.1.4 String or cell replacement
1. Ensure that the system is not operating on backup power.
2. Unplug the battery string at the Anderson connector.
3. Remove the cables and fuses.
4. Remove the battery retaining brackets.
5. Replace batteries and reverse the procedure.
6. Check the battery polarities and the connectors before reinstalling the Anderson connector.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 36 of 38
Page 46

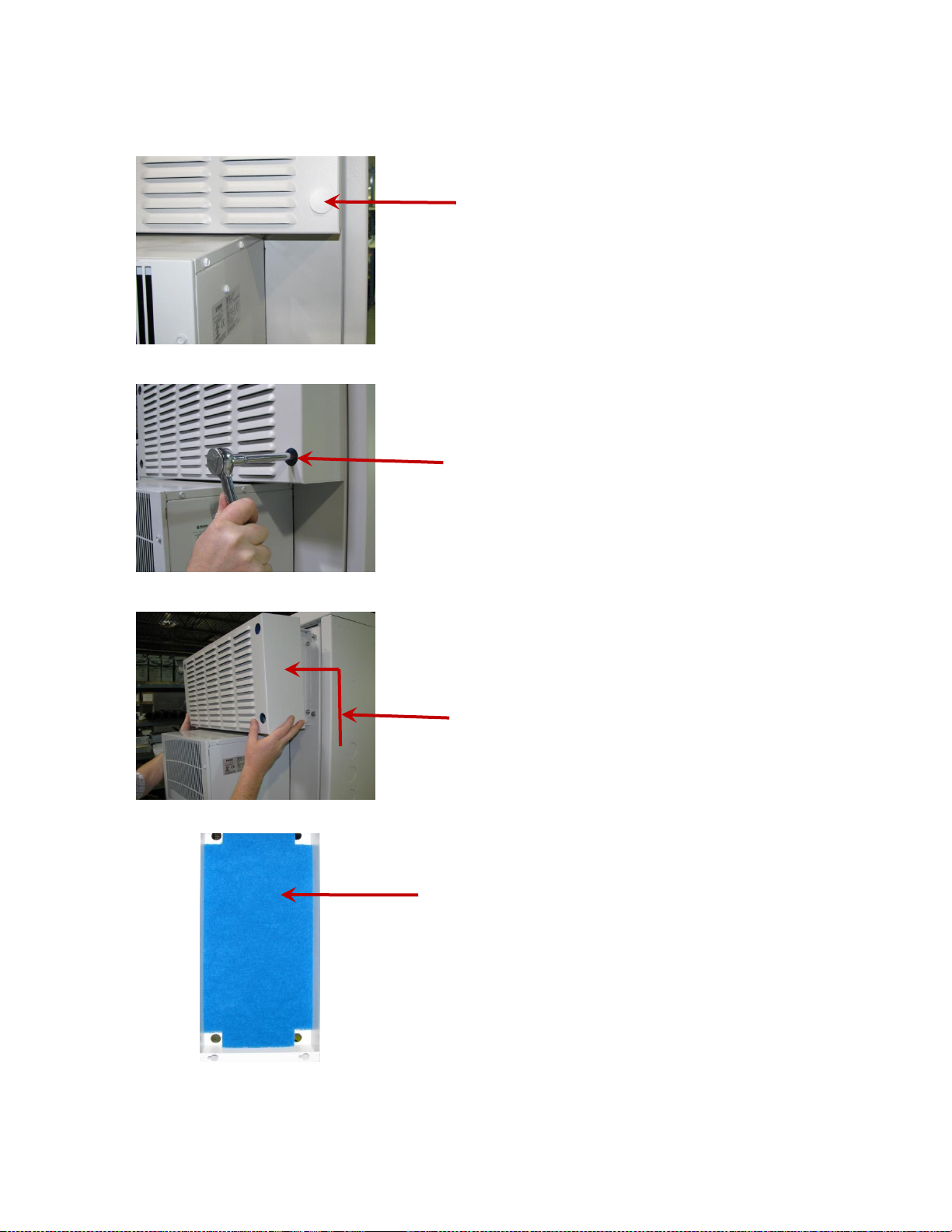

Figure 32 – Plastic plug - 4 positions
Figure 33 – Loosen internal nuts
Figure 35 – Filter is located inside cover
Filter is located inside
panel. Clean or replace
the filter. It is reusable
Reverse the sequence
to re-install the cover.
Slide cover up and
away from door.
Loosen but do not
remove the four
retaining nuts.
Head size is 7/16"
Remove four plastic plugs
to gain access to cover
retaining nuts
Early versions of EVS units use blue filter material and
later versions use grey filter material.
Part # for blue replacement filter: 649-199-10
Part # for grey replacement filter: 649-211-10
Figure 34 – Slide cover up and off
8.2 EVS intake and exhaust filter
An intake and exhaust filter is installed in the EVS intake and exhaust covers located on the front door. The
following filter replacement procedure applies to both the intake and exhaust filter.
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 37 of 38
Page 47
Acronym
Definition
AC
Alternating current
AWG
American wire gauge
BTU
British thermal unit
CSA
Canadian Standards Association
CX
Cordex™ series; e.g., CXC for Cordex system controller
DC
Ground fault circuit interrupter
EVS
Emergency ventilation system
HVAC
Heating, ventilating, and air conditioning
MGB
Master ground bus
NEMA
National Electrical Manufacturers Association
RAM
Random access memory
RU
Rack unit (1.75")
9 Alpha conventions
9.1 Numbering system
Alpha Technologies uses an eight-digit drawing number system, which is broken into three blocks. The first three
digits describe the category of the product; e.g., rectifier or fuse panel. The next three digits indicate the sequence
in which the product number was allocated in a particular category. The last two digits indicate the type of drawing,
for example:
“-06” Outline drawing
“-08” Customer connections
“-20” Main assembly
Alpha Technologies uses an eight-digit part numbering system for all components and sub assemblies. Each part is
covered by its own unique number. Due to the quantity, categories will not be listed within this manual.
9.2 Acronyms
Alpha Technologies Ltd. 057-106-C0 Rev D
Burnaby, British Columbia. Telephone: 604 436 5900 Fax: 604 436 1233. Page 38 of 38
Page 48
Specifications for Alpha Te45 Outdoor Power Enclosure
Electrical
Input Voltage: 120/240 Vac, 60 Hz single phase
120 Vac for auxiliary equipment
120/240 Vac for rectifiers
AC Distribution Panel Options: Main breaker 42 KAIC rated
Output Voltage: 24 Vdc system
48 Vdc system
Output Power: 9.0 kW (5x Cordex 48 V rectifiers; Alpha #010-580-20)
Recommended Feeder Breakers (no integration at ac distribution panel)
Per rectifier shelf : 2 AC feeds:
1 feed (3 rectifiers) 2-pole, 50 A (120/240 Vac single phase)
1 feed (2 rectifiers) 2-pole, 30 A (120/240 Vac single phase)
Supplied Feeder Breakers (integrated at ac distribution panel)
Per rectifier shelf: 2 AC feeds (Integrated at load center):
1 feed (3 rectifiers) 2-pole, 50 A (120/240 Vac single phase)
1 feed (2 rectifiers) 2-pole, 30 A (120/240 Vac single phase)
Mechanical
Dimensions: 1829 mm H x 762 mm W x 762 mm D
(72" H x 30" W x 30" D)
1829 mm H x 1016 mm W x 1067 mm D w/ 200 A AC panel
(72" H x 40" W x 42" D)
Weight: 355 kg (780 lb.), no batteries, no rectifiers; no AC panel
455 kg (1000 lb.), no batteries, no rectifiers, with AC panel
Mounting: Pad or platform
Cooling: 4000 btu air conditioner with built in 500 W heater
Enclosure: Aluminum, 5052-H32
Internal Rack: 19"/23", 39 RU
Specifications for Alpa Te45 Outdoor Power Enclosure Continued
Environmental
Operating Temperature: -40 to +46°C
(-40 to 115°F)
Storage Temperature: -40 to +85°C
(-40 to +185°F)
Humidity: 0 to 95% non-condensing
Elevation: 3600 m, see Operating Temperature
(12,000 feet)
Weather Tightness: NEMA Type 3R
Regulatory Approvals
Enclosure Ratings: CSA/UL Type 3R
Product Safety: CSA/UL 60950
The above information is valid at the time of publication. Consult factory for up-to-date ordering information. Specifications are subject to change without notice.
DESCRIPTIONLTRAPPDDATEDWNCHKD
UPDATED MODELP/B
USE OBROUND MT HOLEP/C
REVISIONS
ME09/10KLJK
RP09/11KLJK
0
25.4 1.00
736.6 29.00
BASE LAYOUT (TOP VIEW)
1051.2 41.39
685.8 27.00
76.2 3.00
0
1455.1 57.29
1878.6 73.96
1832.0 72.13
1757.3 69.18
1719.2 TYP67.69
1681.1 TYP66.19
1643.0 TYP64.69
1452.5 57.18
1448.9 57.04
OPTIONAL
AC PANEL
50.4KO 1.98
(C) FOR TRADE SIZE
619.8 24.40
1-1/2" CONDUIT
21.8 0.86
660.4 26.00
669.3 26.35
(D) FOR DRAIN PLUG
62.7KO 2.47
(E) FOR TRADE SIZE
2" CONDUIT
KO SHOWN ABOVE
ARE LOCATED AT
BOTTOM OF
OPTIONAL AC PANEL
468.1 18.43
239.5 9.43
153.4 6.04
58.2 2.29
576.6 22.70
D
E
C
00
0
81.0 3.19
169.9 6.69
FRONT
71.1 2.80
690.9 27.20
92.7 3.65
CONCRETE PAD OR PLATFORM MOUNTING
287.0 11.30
12.7 0.50
228.6 TYP9.00
304.8 TYP12.00
381.0 TYP15.00
457.2 TYP18.00
533.4 TYP21.00
749.3 29.50
762.0 30.00
0
128.3 TYP5.05
(USE THESE SLOTS FOR SEISMIC)
19.1 [0.75] X 57.2 [2.25] 4 PLACES
CONCRETE PAD MOUNTING:
REMOVE OBROUND KNOCKOUT DRILL AND
INSTALL CONCRETE ANCHOR BOLTS AND
SQUARE SEISMIC WASHER.
USE HILTI HSLB-M12/25 ANCHORS (ARGUS
P/N 660-019-10) OR EQUIVALENT, AND
SEISMIC WASHER (ARGUS P/N 615-269-R8)
SUPPLIED.
PLUG 4 OUTERMOST BASE HOLES WITH
ABBBAAA
28.2KO 1.11
(B)
FOR TRADE SIZE
3/4" CONDUIT
1762.3 69.38
1619.3 63.75
5/8" PLASTIC PLUGS (ARGUS P/N 642-020-
10) SUPPLIED
1252.2 49.30
1162.1 45.75
PLATFORM MOUNTING:
USE APPROPRIATE MOUNTING HARDWARE
712.3 28.04
642.6 25.30
ITEM
501.7 19.75
352.6 13.88
BB
136.7 TYP5.38
47.8 1.88
0
0
91.3
KO 3.59
0
(A)
FOR TRADE SIZE
3" CONDUIT
165.0 6.50
66.0 TYP2.60
596.8 23.50
762.0 30.00
721.3 TYP28.40
57.2 TYP2.25
95.3 TYP3.75
666.8 TYP26.25
704.9 TYP27.75
357.6 TYP14.08
306.8 TYP12.08
256.0 TYP10.08
205.2 TYP8.08
0
273.1 10.75
THESE DESIGNS AND SPECIFICATIONS ARE CONFIDENTIAL, REMAIN
33.0 1.30
0
0
NAME DATE
721.4 28.40
40.6 1.60
247.7 9.75
311.2 12.25
DESIGN2009/07
DRAWN
CHECKED
APPROVED
RP
KL
RP
2009/07
2009/07
2009/07
JK
THE PROPERTY OF ARGUS TECHNOLOGIES LTD., AND SHALL NOT
BE COPIED OR USED WITHOUT ITS WRITTEN CONSENT.
UNITS: mm [in]
X [X.X]
X.X [X.XX]
X.XX [X.XXX]
ANGULAR:
THESE DESIGNS AND SPECIFICATIONS ARE THE PROPERTY OF
ARGUS TECHNOLOGIES AND SHALL NOT BE COPIED OR USED
FOR MANUFACTURING WITHOUT ITS WRITTEN CONSENT.
Title
SCHEMATIC, INTERFACE KIT W/
CABLE SET, POWER TO BATTERY,
Te45
ISSUE
DATE
SIZE
TYPE
DWG NO.
B
4
5
S5
6
3 3
of
Sheet
Rev
P/A
Page 60

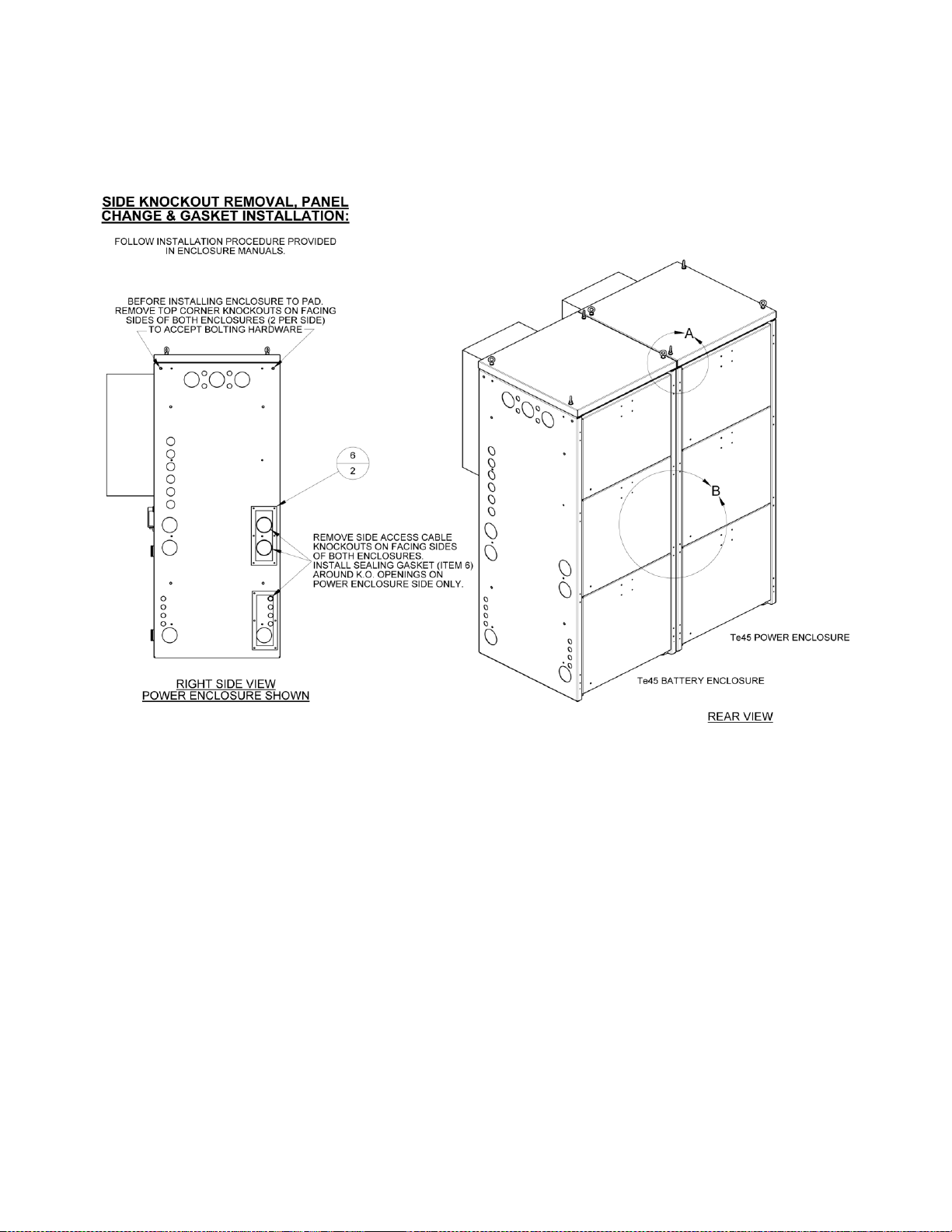

SIDE KNOCKOUT REMOVAL, PANEL
CHANGE & GASKET INSTALLATION:
POWER AND BATTERY ENCLOSURE CONFIGURATION
SETUP & PREPARATION:
DESCRIPTIONLTRAPPDDATEDWNCHKD
REVISIONS
UPDATED WIRINGP/B
ME2009/12SDWJK
FOLLOW INSTALLATION PROCEDURE PROVIDED
IN ENCLOSURE MANUALS.
BEFORE INSTALLING ENCLOSURE TO PAD.
REMOVE TOP CORNER KNOCKOUTS ON FACING
SIDES OF BOTH ENCLOSURES (2 PER SIDE)
TO ACCEPT BOLTING HARDWARE
REMOVE SIDE ACCESS CABLE
KNOCKOUTS ON FACING SIDES
OF BOTH ENCLOSURES.
INSTALL SEALING GASKET (ITEM 6)
AROUND K.O. OPENINGS ON
POWER ENCLOSURE SIDE ONLY.
RIGHT SIDE VIEW
POWER ENCLOSURE SHOWN
DETAIL A - INSIDE VIEW
A
EXISTING
CUT LINES
6
2
B
DETAIL B - INSIDE VIEW
CUT AWAY A SMALL SECTION OF INNER
WALL INSULATION IN AREA OF SIDE
ACCESS CABLE KNOCKOUTS ON
BOTH ENCLOSURES AS SHOWN FOR
Te45 POWER ENCLOSURE
Te45 BATTERY ENCLOSURE
CHASE NIPPLE INSTALLATION.
ITEM
QTY
REAR VIEW
INSULATION CUT DETAIL
NAME DATE
DESIGN2009/09
DRAWN
CHECKED
APPROVED
ME
KL
ME
JK
2009/09
2009/09
2009/09
THESE DESIGNS AND SPECIFICATIONS ARE CONFIDENTIAL, REMAIN
THE PROPERTY OF ARGUS TECHNO LOGIES LTD., AND SHALL NOT
BE COPIED OR USED WITHOUT ITS WRITTEN CONSENT.
UNITS: mm [in]
X [X.X]
X.X [X.XX]
X.XX [X.XXX]
ANGULAR:
POWER ENCLOSURE TO BATTERY ENCLOSURE
INTERFACE CABLE ROUTING & CONNECTIONS CONT'D:
NEATLY STRAP INTERFACE CABLES
TO TIE-OFF BAR USING CABLE TIES
(ITEM 37) PROVIDED IN KIT.
INTO BATTERY ENCLOSURE
FROM POWER ENCLOSURE
BATTERY ENCLOSURE REAR BATTERY CHARGE
TERMINATION PANEL CABLE ROUTING
CONNECT X2 #4/0 AWG
(-) CABLES FROM Te45
POWER ENCLOUSURE
CONNECT X2 #4/0 AWG
(+) CABLES FROM Te45
POWER ENCLOSURE
CABLE TIE-OFF
BAR AND SCREW
(ITEM 4, 18)
(-)
(+)
POWER ENCLOSURE CHARGE TERMINATION PANEL
CONNECTIONS AND CABLE ROUTING
CONNECT INTERFACE CABLES TO THEIR RESPECTIVE (+) AND (-) BUS BARS ON
CHARGE TERMINATION PANEL USING 3/8" HARDWARE SUPPLIED AS SHOWN.
ENSURE CORRECT POLARITY IS OBSERVED WHEN MAKING CONNECTIONS.
USE A MULTIMETER TO CHECK ALL TERMINATIONS BEFORE
CONNECTING BATTERIES AND APPLYING POWER TO THE SYSTEM.
DRAPE INTERFACE CABLES DOWN
USE CABLE TIES PROVIDED TO NEATLY
DRESS/BUNDLE CABLES TOGETHER.
REAR CABLE ROUTING BETWEEN ENCLOSURES
NEATLY ROUTE CABLES THROUGH
BOTH CHASE NIPPLE FITTINGS.FROM CABLE TIE-OFF BAR.
PUT POSITIVE CABLES THROUGH
TOP NIPPLE AND NEGATIVE CABLES
THROUGH BOTTOM NIPPLE TO
KEEP CABLES ORGANIZED.
BATTERY CHARGE
TERMINATION PANEL
FRONT BATTERY CHARGE
TERMINATION PANEL CONNECTIONS
REAR POWER ENCLOSURE CHARGE
TERMINATION PANEL CONNECTIONS
THESE DESIGNS AND SPECIFICATIONS ARE CONFIDENTIAL, REMAIN
THE PROPERTY OF ARGUS TECHNO LOGIES LTD., AND SHALL NOT
BE COPIED OR USED WITHOUT ITS WRITTEN CONSENT.
UNITS: mm [in]
X [X.X]
X.X [X.XX]
X.XX [X.XXX]
ANGULAR:
ROUTE AIR CONDITINER POWER CORD THROUGH
3/4" NIPPLE BETWEEN BATTERY AND POWER ENCLOSURES.
ROUTE THROUGH POWER ENCLOSURE FOR CONNECTION
TO EXTERNAL AC PANEL.
CSA (Canadian Standards Association also known as CSA International) was established in 1919 as
an independent testing laboratory in Canada. CSA received its recognition as an NRTL (Nationally
Recognized Testing Laboratory) in 1992 from OSHA (Occupational Safety and Health Administration) in
the United States of America (Docket No. NRTL-2-92). This was expanded and renewed in 1997, 1999,
and 2001. The specic notications were posted on OSHA’s ofcial website as follows:
Federal Register #: 59:40602 - 40609 [08/09/1994]
Federal Register #: 64:60240 - 60241 [11/04/1999]
Federal Register #: 66:35271 - 35278 [07/03/2001]
When these marks appear with the indicator “C and US” or “NRTL/C” it means that the product is
certied for both the US and Canadian markets, to the applicable US and Canadian standards. (1)
Argus rectier and power system products, bearing the aforementioned CSA marks, are
certied to CSA C22.2 No. 950 and UL 1950, or CSA/UL 60950.
As part of the reciprocal, US/Canada agreement regarding testing laboratories, the Standards Council
of Canada (Canada’s national accreditation body) granted Underwriters Laboratories (UL) authority to
certify products for sale in Canada. (2)
Only Underwriters Laboratories may grant a licence for the use of this mark, which indicates compliance
with both Canadian and US requirements. (3)
What are NRTLs and what do they do?
NRTLs are third party organizations recognized by OSHA, US Department of Labor, under the NRTL
program.
The testing and certications are based on product safety standards developed by US based standards
developing organizations and are often issued by the American National Standards Institute (ANSI). (4)
The NRTL determines that a product meets the requirements of an appropriate consensus-based
product safety standard either by successfully testing the product itself, or by verifying that a contract
laboratory has done so, and the NRTL certies that the product meets the requirements of the product
safety standard. (4)
The product on which either of these marks appear
has been certied by CSA as meeting applicable
Canada/US standards.
The product on which this mark
appears has been certied by UL
as meeting applicable Canada/US
standards.
When was the NRTL started and who governs it?
In 1983, in a suit brought on by an independent testing laboratory, OSHA was court ordered to remove
specic references to UL (Underwriters Laboratories) and FMRC (Factory Mutual Research Corporation)
from its regulations.
In 1988, OSHA revised its regulations to remove those references and the NRTL program was
established.
The NRTL Program is both national and international in scope with foreign labs permitted.
References:
Information in this document has been developed from the ofcial websites of the respective
organizations.
(1) www.csa-international.org
(2) www.scc.ca
(3) www.ulc.ca
(4) www.osha.gov
