Openreach ONT Developer's Manual

Page 1
bre
network
Developer Guide
Version 7.1 – August 2018
How to build a
Page 2
2.
5.
Multi dwelling Units (MDUs)
8.
Modular jointing chambers – Quadbox
TM
3.
Developer self-install
6.
Commercial units
11.
Health and safety advice
9.

Joint boxes, footways and frames & covers
4.
Cabling and ONT positioning
7.

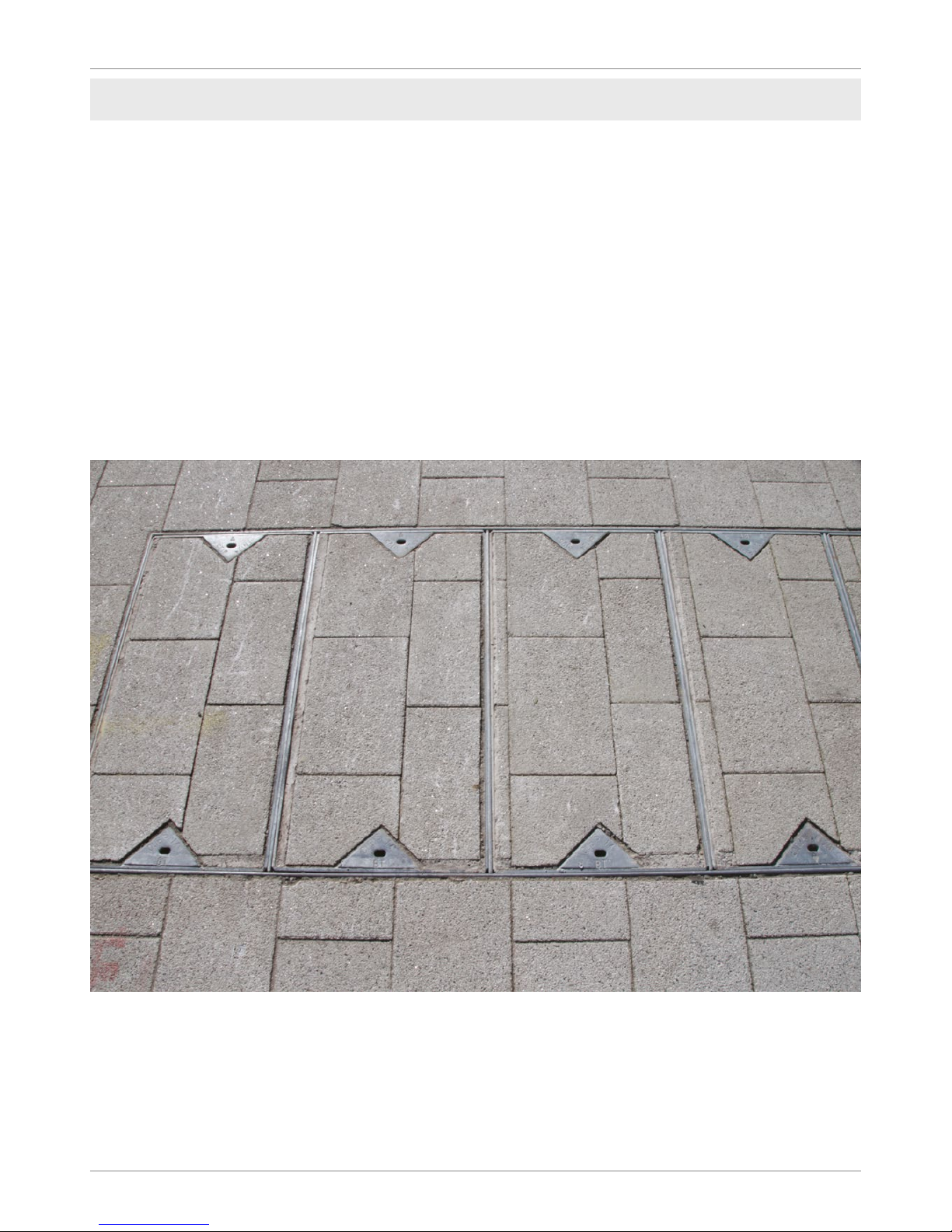

Duct laying
10.
List of abbreviations and acronyms
CON
TENTS
1.
Internal equipment
12.
Quality control checklist
Page 3
3
Internal equipment
1
The ONT is the Openreach demarcation point. It replaces the traditional copper master socket.
The Openreach ONT sits in an enclosure along with the Battery Backup Unit (BBU) and associated wiring, keeping everything neat and tidy. The enclosure is designed for simple wall mounting with just 2 screws.
• Optical port connects to the external Customer Splice Point.
• Ethernet port connects to the communications provider's (CP) router.
• Telephony port connects to voice network.

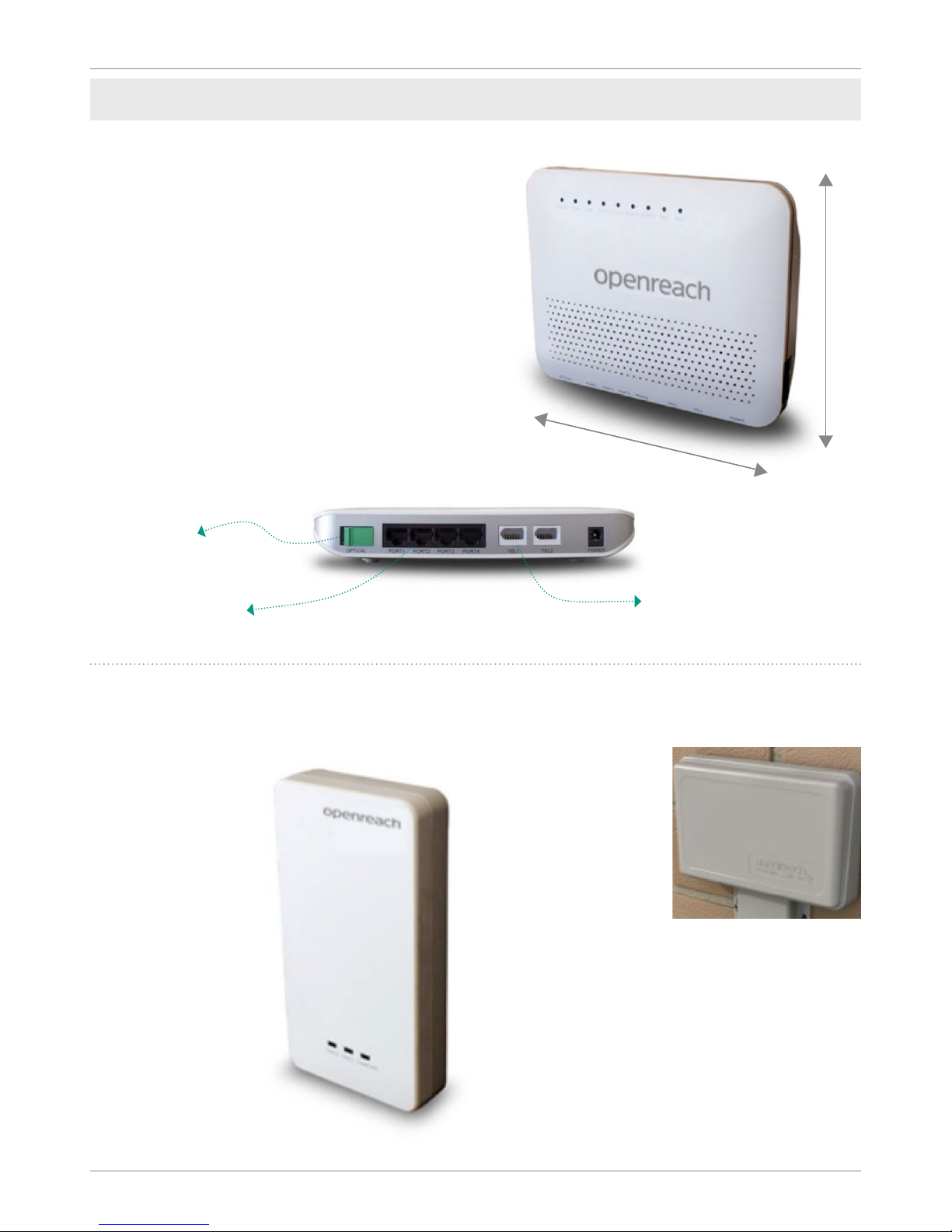

Openreach Optical Network Termination (ONT) and enclosure
254mm
215mm
Battery Backup Unit (BBU)
The BBU sits in the enclosure along with the ONT. It supports voice calls for approximately an hour should there be any interruption to the mains power supply.
A red warning light will ash when a replacement battery is required. Openreach warranties the battery for 90 days, where it then becomes the responsibility of the home owner.
How to build a fibre network - version 7.1
Page 4
4
Openreach: Developer Guide
Internal equipment
Legacy ONT
The legacy ONT was the previous piece of equipment used before the introduction of the 1+1 in January 2018.
This ONT is mounted directly to the wall and has no associated enclosure.
• Optical port connects to the external Customer Splice Point.
• Ethernet ports connect to the CP router.
• Telephony ports connect to voice network.
155mm
195mm
Optical
port
Ethernet
ports
Telephony
ports

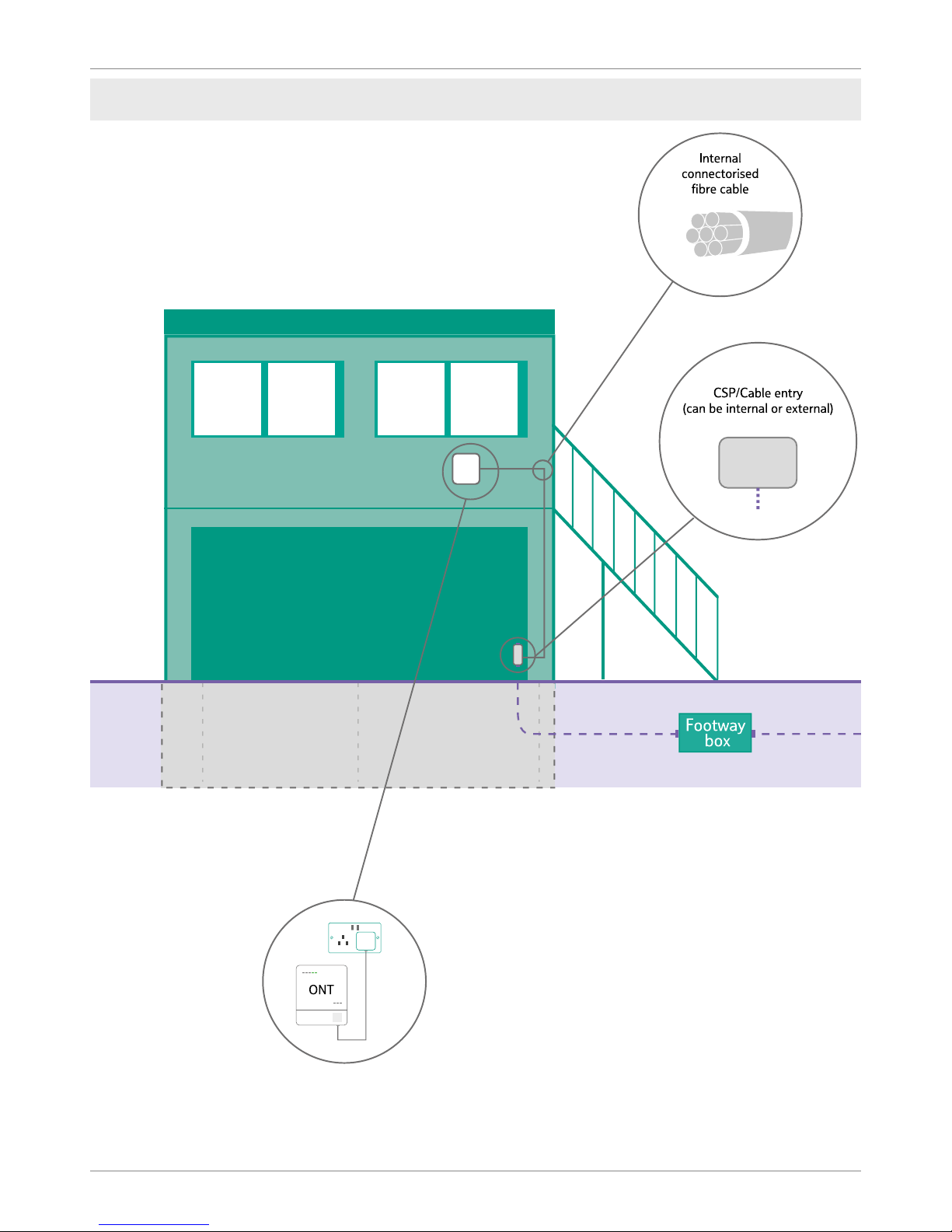

The CSP houses the external connectorised bre cable and the connected end that ts into the ONT. The CSP sits of the outside of the house.
Where you self-install there will be no internal CSP, instead the connectorised cable will plug directly into the ONT. If the connectorised cable end is damaged during installation then an internal CSP may be required to be tted to complete installation. This will be undertaken at the commissioning stage by Openreach. Your Field Based Co-ordinator (FBC) will guide you through this.
BBU
The battery backup supports voice calls for approximately one hour should there be any interruption to the mains power supply. A red warning light will ash when a replacement battery is required.
Openreach warranties the battery for 90 days, where it then becomes the responsibility of the home owner.
Customer Splice Point (CSP)
Page 5
5
The wiring that you install in your customer’s properties is pivotal to their experience.
Your options in the installation of internal wiring are shown as below
Implications of locating the service provider’s router in a cupboard
It is important to note that the Wi-Fi service your customer receives is dependent upon the intended location of the communication provider’s router. Placing the router in a service cupboard or under stairs cupboard will signicantly reduce the speed and coverage your customer will receive.
It is highly recommended that if you position the router in this way that you provide additional RJ45 ports within the home. Ideally for optimum speeds to be enjoyed using Wi-Fi service it is recommended that you locate the router centrally within the property.
For information, advice and guidance around positioning, please refer to: PAS: 2016 Next Generation Access for new Build Homes Guide.
All internal wires and sockets beyond the ONT are the responsibility of the developer/ future home owner.
If any part of the connectorised internal bre cable is found to be damaged at commissioning, it is the developer’s responsibility to replace it.
If the homeowner experiences a lack of service or poor service, which is due to a fault within the internal installation of wiring, which requires Openreach to rectify, the homeowner will be charged.
Please note
Home wiring
2
How to build a fibre network - version 7.1
Page 6
6
Openreach: Developer Guide

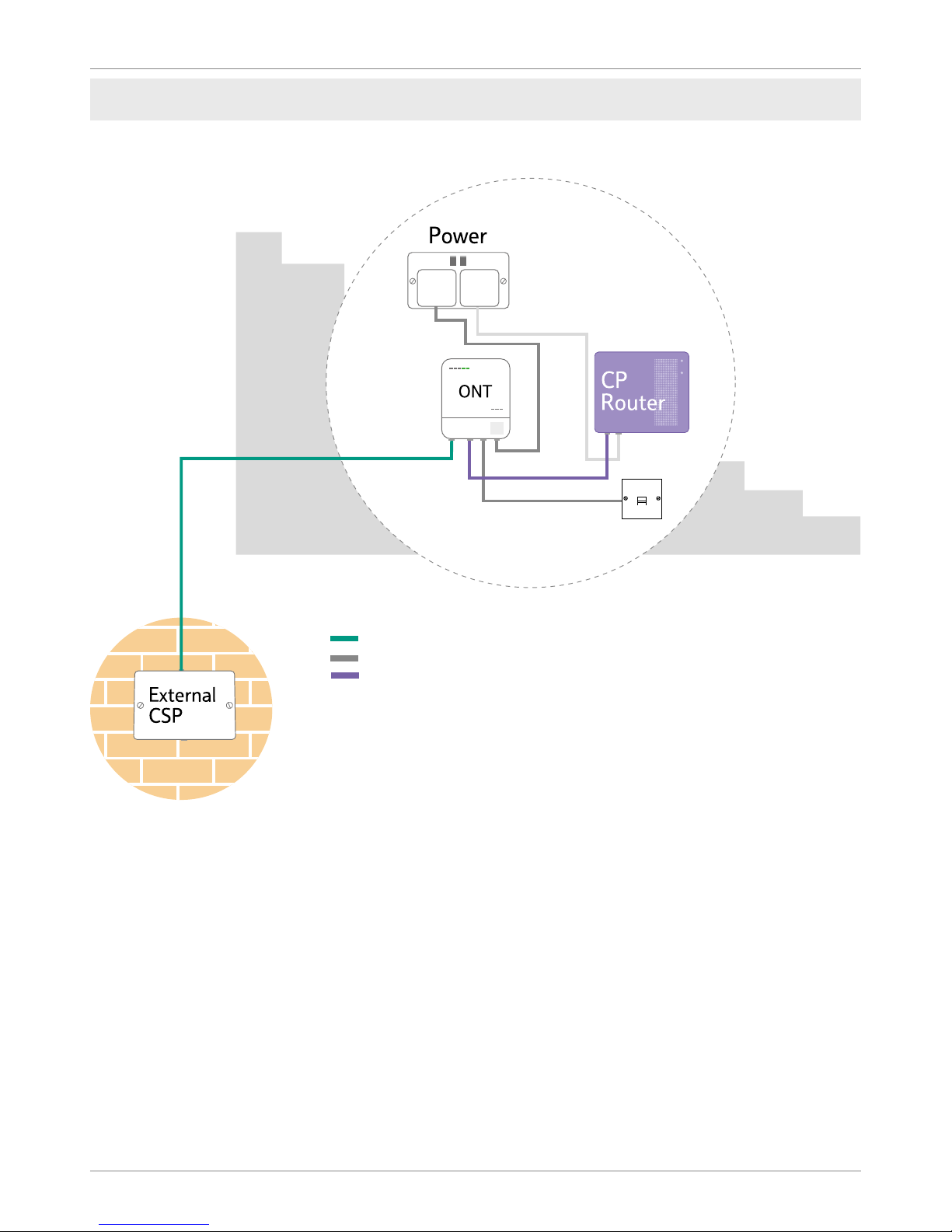

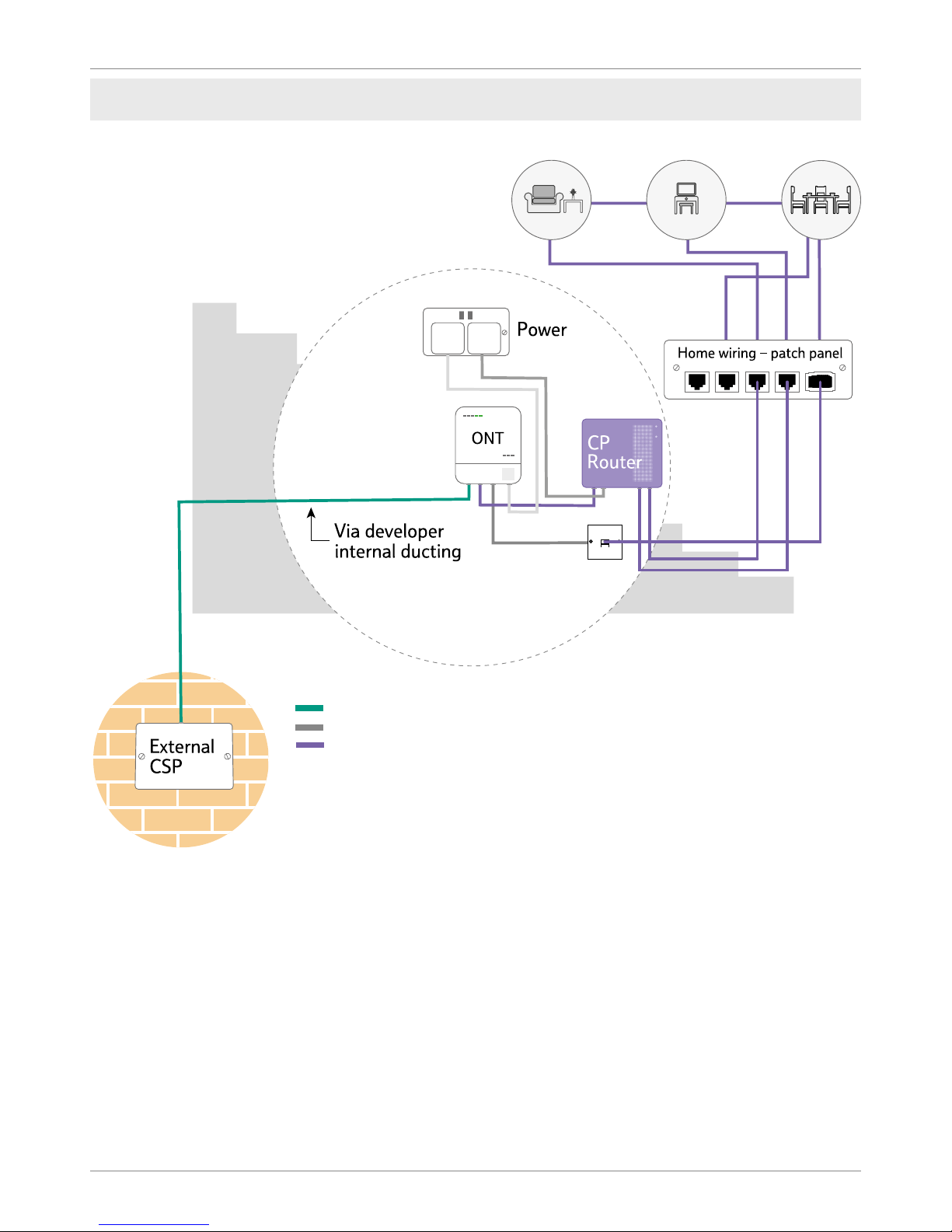

The simple install
The simplest installation will be the provision of the Openreach equipment (i.e. the ONT will be positioned adjacent to the outside wall) to which the customer then attaches the router, provided by their communications provider. Without internal data cabling, this relies on wireless extenders using.
the homes electricity cabling system to provide internet connection to other rooms in the house. Power sockets should be provided for the Openreach equipment and for the communications provider’s router and for the wireless extenders / adaptors if used.
CSP: Customer Splice Point
ONT: Optical Network Termination
BBU: Battery Backup Unit
Option 1
Connectorised bre cable
Voice cable Ethernet cable
Home wiring
External
Internal
Page 7
7
Option 2

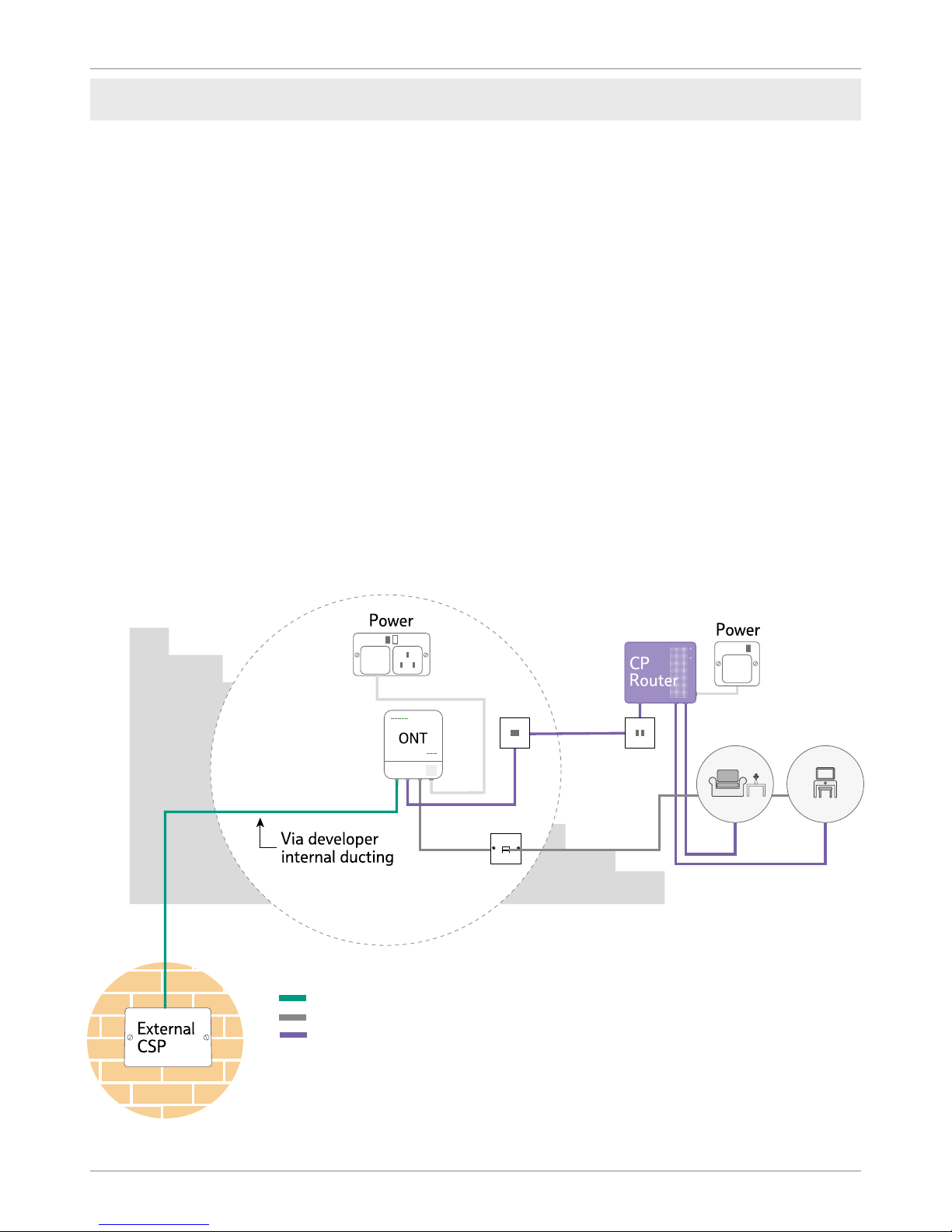

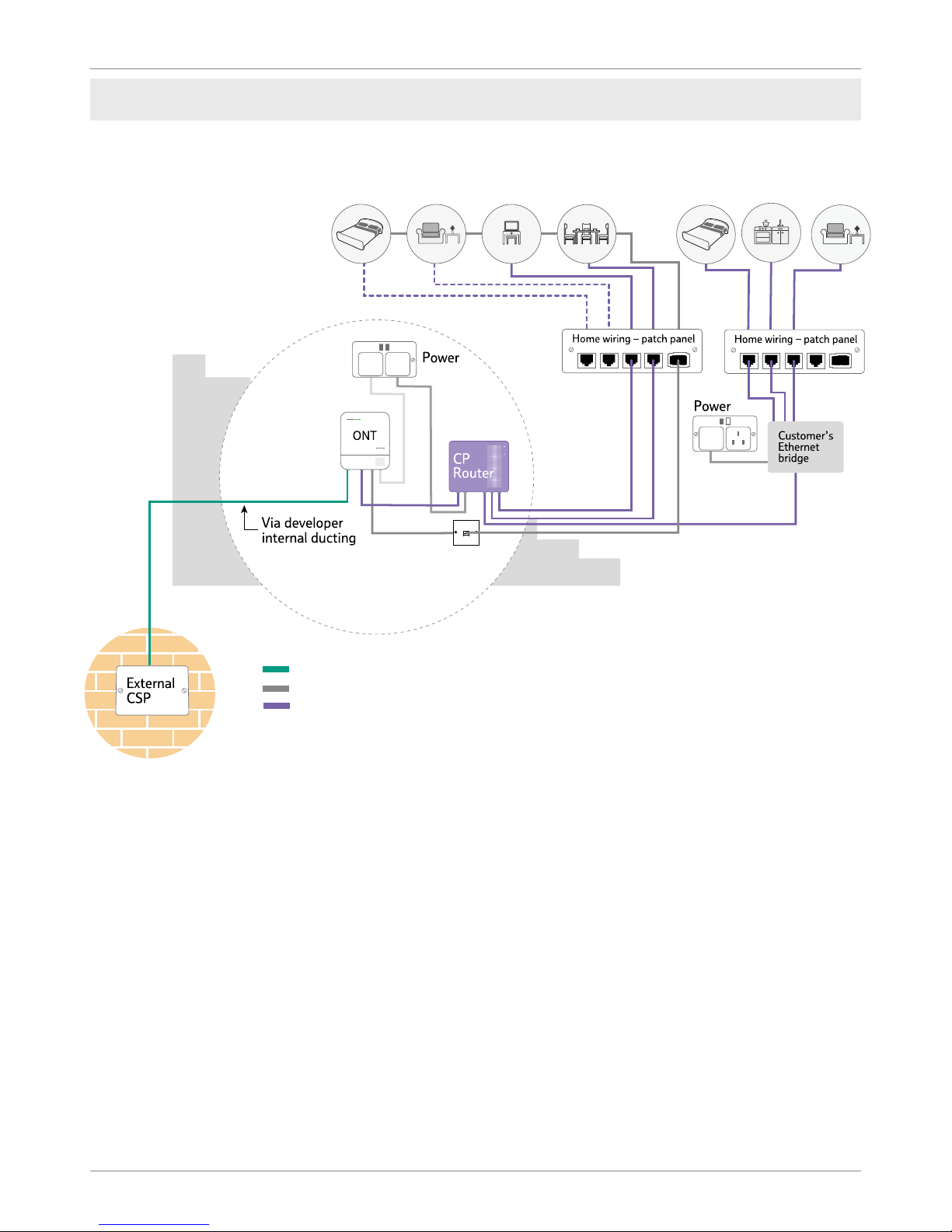

Relocating the ONT and BBU
Some developers want to position the v and Battery Backup Unit (BBU) further inside the property. This will require a longer connectorised internal bre cable which is recommended to be installed in a protective conduit to the external Customer Splice Point (CSP) plus the provision of a power socket for the equipment. Additional Cat6* cabling is required for this option from the ONT & BBU to connections in the study and living room. These connections should terminate in an RJ45 socket. A power socket should be provided for the communications provider’s router, if the router is placed near the RJ45 socket or a double socket if it is placed by the ONT and BBU.
*Cat6 is the preferred option to ‘future proof’ for modern devices
CSP: Customer Splice Point
ONT: Optical Network Termination
BBU: Battery Backup Unit
Connectorised bre cable
Voice cable Ethernet cable
Home wiring
How to build a fibre network - version 7.1
Page 8
8
Openreach: Developer Guide
As per option 2 this extends the number of xed sockets so that the home owner doesn’t need to rely on wireless connections in the majority of the house. This would enable the down-streaming of 4K television in those areas where the customer is most likely to use high bandwidth applications like streaming TV, gaming consoles or video conferencing.
One double power socket should be provided for the Openreach equipment and for the communications provider’s router. We recommend that all the data cabling from the rooms are terminated in a data patch panel (example as below) in close proximity to the ONT to facilitate easy connection.
It is also recommended that where an aerial socket is provided for televisions that an ethernet data socket and associated wiring is also provided.
CSP: Customer Splice Point
ONT: Optical Network Termination
BBU: Battery Backup Unit
Connectorised bre cable
Voice cable Ethernet cable
Relocating the ONT and BBU and adding data points in multiple rooms
Home wiring
Option 3
Page 9
9
Home wiring
The networked home
This option offers data cabling from wherever the Openreach ONT & BBU equipment is located, to all rooms in the home using a home wiring patch panel and RJ45 data sockets throughout. This could be offered either as standard or a customer paid option and will guarantee the best customer experience and help differentiate your property.
We recommend that all the data cabling from the rooms are terminated in a data patch panel in close proximity to the ONT (Optical Network Termination) or the communications provider’s router to facilitate easy
connection.
Option 4
CSP: Customer Splice Point
ONT: Optical Network Termination
BBU: Battery Backup Unit
Connectorised bre cable
Voice cable Ethernet cable
How to build a fibre network - version 7.1
Page 10
10
Openreach: Developer Guide
Home wiring
When Openreach install the equipment we will install the ONT wherever the incoming bre cable is located. Where you self-install the ONT, you will have control over when the equipment is installed. The ONT will remain the property of Openreach in both installation scenarios.
Where you are self-installing the Openreach equipment we will supply the ONT, along with the battery back-up and the connectorised internal bre cable you need. If you are installing the ONT opposite the cable entry hole, you will need to install a ush mounted double back box on the internal wall where the ONT is to be located.
The ONT will be installed at this location unless an alternative position has been agreed with your FBC and the appropriate connectorised internal bre cable run in a continuous fault-free length to the alternative position.
While the provision of internal wiring beyond the Openreach ONT is the responsibility of the developer, you can contract an Openreach engineer to do this work for you. If interested, please contact your local customer network solutions team on 0800 783 2023. Terms and Conditions for the provision of internal wiring will apply.
Provision of the Openreach equipment
Voice Cabling
• Voice extension cabling shall run direct from the ONT voice port. Connection to the ONT is made via a BS6312 431A Plug inserted into voice port 1. This socket must be a slave socket, not a master socket.
• Extension sockets shall be located close to power sockets for easy equipment connection. A minimum of 50mm between telephone cables and power cables shall be left throughout.
• Where this isn’t practical, telephone and power cables must be separated by an acceptable divider (i.e. of rigid, non-conducting material).
• Extension wiring must be telephone/data grade and have plain annealed solid copper conductors of a diameter between 0.5mm and
0.63mm. The conductors shall be in twisted pair format. The conductor resistance shall be of a maximum of 96 ohms/km. The cable sheath shall be PVC.
Data Cabling
• As a rule of thumb connectorised internal bre cables shall not exceed the minimum bend radius (i.e. no smaller than) of a £2 coin.
• Detailed information on cable installation and separation is given in the British Standards.
• Code of Practice 6701, Part 1 (particularly clause 6) and the relevant sections of the latest IEE Regulations for electrical Installation (Regulation 525 is of particular importance).
• The wiring pattern for cabling must be either in series or spur. For data it must be point to point as speeds will be impacted after the rst point of a daisy chain.
• We’d recommend data cabling rooms likely to benet most from a physical connection, like the room with the main TV and the home ofce.
Please note: If connectorised cable is damaged by developers during installation then an internal Splice Point may be required to be tted to complete installation. This will be undertaken at commissioning stage by Openreach.

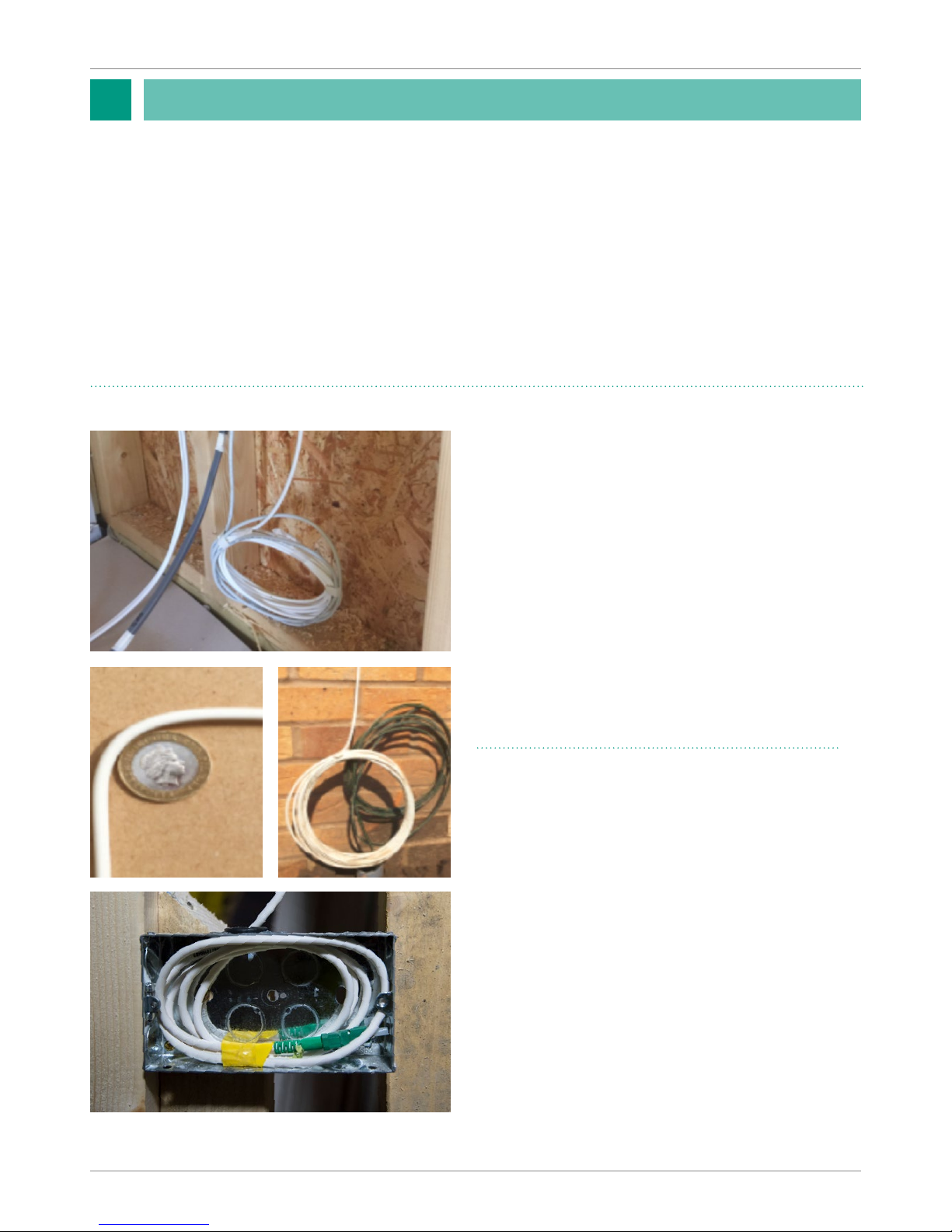

Installation of internal cabling
How to build a fibre network - version 7.1
Page 11
11

• Fit the double electrical socket to the wall.
• Fit the double back box to the wall.
• Fit the slave voice socket to the wall (can be modular to house one voice port and one data port).
• Fit RJ45 modular boxes. The number of these are to be determined by you the developer Openreach recommend a minimum of two are tted, one for the communications provider router and the other to the room requiring streaming media for example for streaming high denition TV. See the internal wiring section for further information.
• All internal wiring to be run back to this point (daisy chain for voice and point to point for data).
• See below for the recommended layout of sockets on the wall, the layout can be mirrored.
Internal Work at dened ONT and Communications
Provider router position
Single Dwelling Unit at second
x (Internal Work)
• Fit the enclosure to the wall over the double back box using the supplied template.
• Take the pre-connectorised cable from back box to the ONT position.
• Connect the BBU to the ONT power port.
• Clean both the pre-connectorised cable and the optical port of the ONT before inserting the cable.
A video showing the installation of the internal equipment can be found on the Openreach developer website at the following link:
https://www.ournetwork. openreach.co.uk/property­developers/developer-handbooks­and-extra-services.aspx
Developer self-install
3
How to build a fibre network - version 7.1
Page 12
12
Openreach: Developer Guide

Remove the cap from the green bre connector and use the One Click cleaner to clean both the connector and the optical port on the ONT. Once cleaned plug into the Optical port on the ONT. Care must be taken at this stage not to contaminate the end of the bre connector to avoid any dirt from inhibiting the data signal.
Open the green ap on the Optical port and insert the bre cable. The cable is designed to t only one way, so ensure the raised nodule is facing the wall when inserting.
• Connect the alarm lead between the RJ45 socket on the BBU and the BBU port on the ONT.
• Connect the ethernet cable to the PORT 1 port on the ONT. The other end of this cable will be connected to the CP router once ordered.
• Connect the telephone cable to the TEL 1 port on the ONT and plug into the Slave socket on the wall (this cable is a separate item and will be provided by your FBC).
• Connect the mains adaptor to the BBU and plug into the mains socket.
• You can see the nal layout and cable connections here, ensure the cable lengths are correctly positioned within the enclosure before continuing.
Developer self-install
Fujikura are our chosen producer of bre cleaners. The One Click cleaner shown here can be found at the following link:
www.fujikura.co.uk/products/bre-
and-optical-devices/connectivity­and-cleaning/one-click-cleaners/
Please note
Page 13
13
Developer self-install
• Once plot is complete contact your Openreach FBC as each plot is ready for connection (i.e. front door on; power on, ONT area decorated).
• Your Openreach FBC will then raise a job with the Openreach teams to commission the plot(s).
DSI next steps
How to build a fibre network - version 7.1
Page 14
14
Openreach: Developer Guide
For Single Dwelling Units a pre-connectorised cable will be available in different lengths (5m, 20m, 30m, 50m and 100m) and will come in individual bags that can be ordered via the FBC. A minimum length of 2m of excess cable will be left coiled externally for ease of installation.
Once the pre-connectorised cable is installed then Openreach (or their third party) will visit to terminate the pre-connectorised cable at the external CSP location back to the serving Splitter location(s) and then commission the plot.
Single dwelling units
Run the pre-connectorised cable from agreed ONT position back to external Customer Splicing Point (CSP).

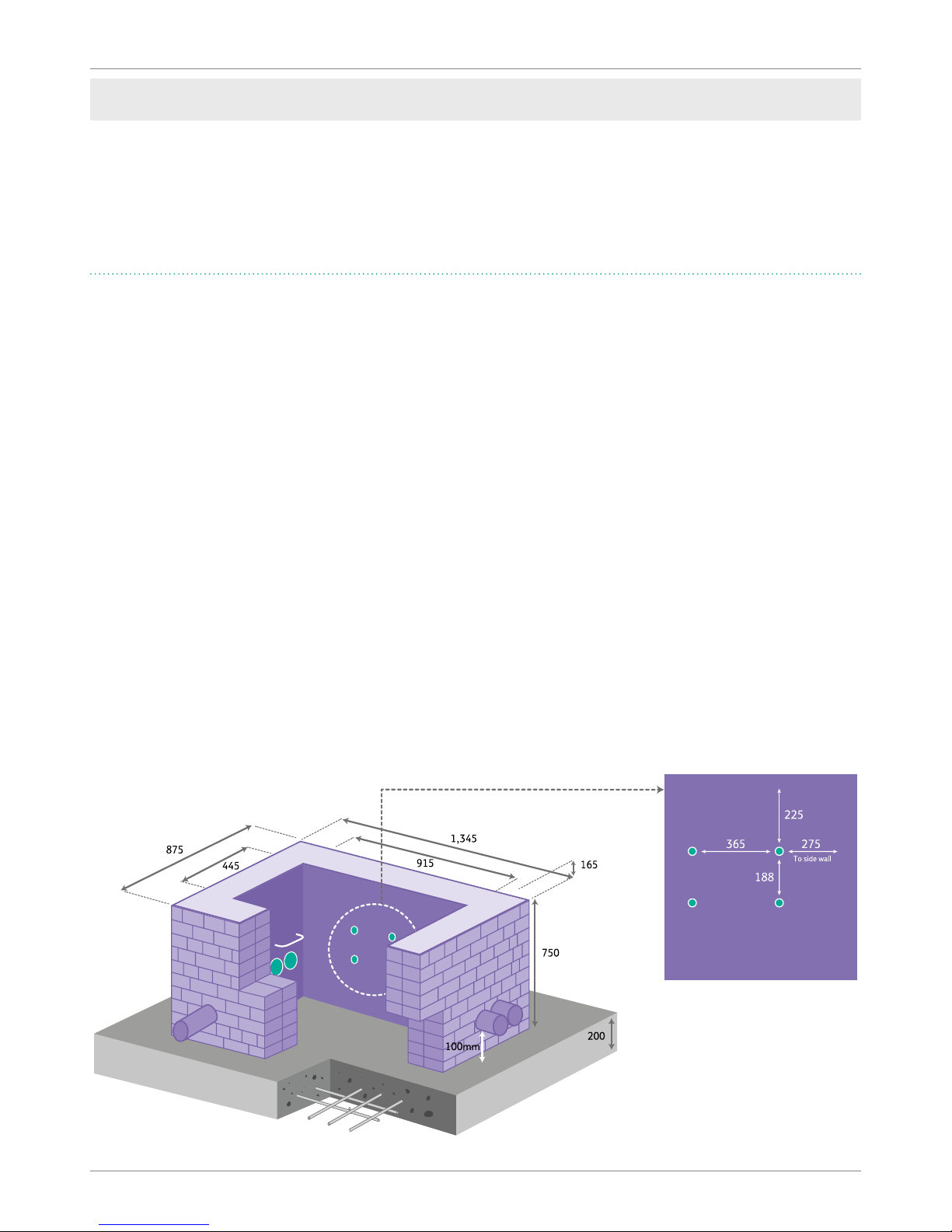

The bend radius of cable must meet all necessary installation requirements i.e. no 90 degree bends.
Coil 1m of pre-connectorised cable into the empty double back box, taking care not to damage the connectorised
end and t blanking plate to help protect bre.
Ensure the green caps on the end of the
connectorised internal bre cable are
kept on during construction to avoid
damage to the bre cable.
Installation of pre-connectorised
cable at rst x (Internal Work)
Step 1
Step 2
Cabling and ONT positioning
4
Page 15
15
Complying with Building regulations
Even where you are not working with Openreach or another infrastructure company to provide a functioning broadband and phone infrastructure to the home the Part R regulations require the provision of duct in the default position discussed below so that infrastructure can be installed in the future.

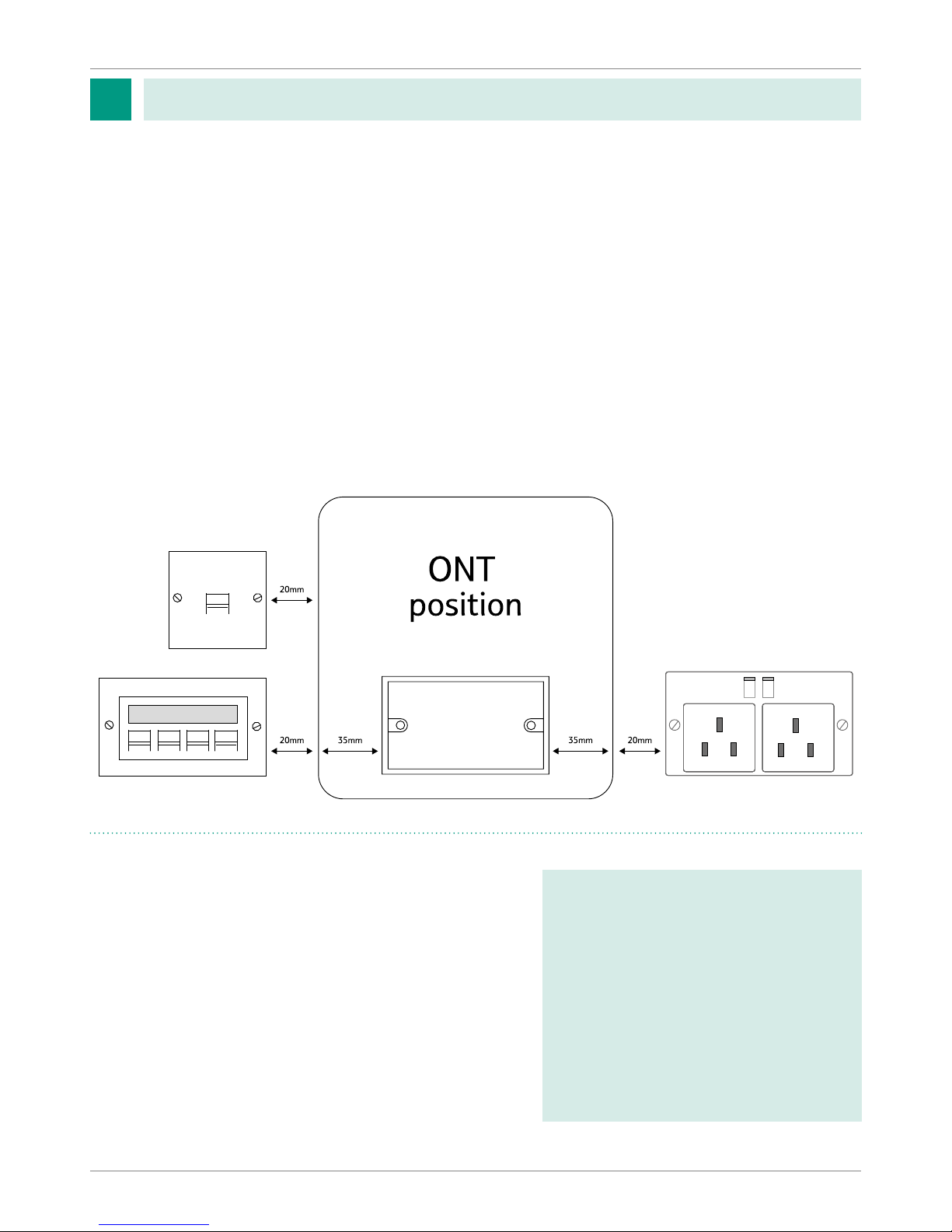

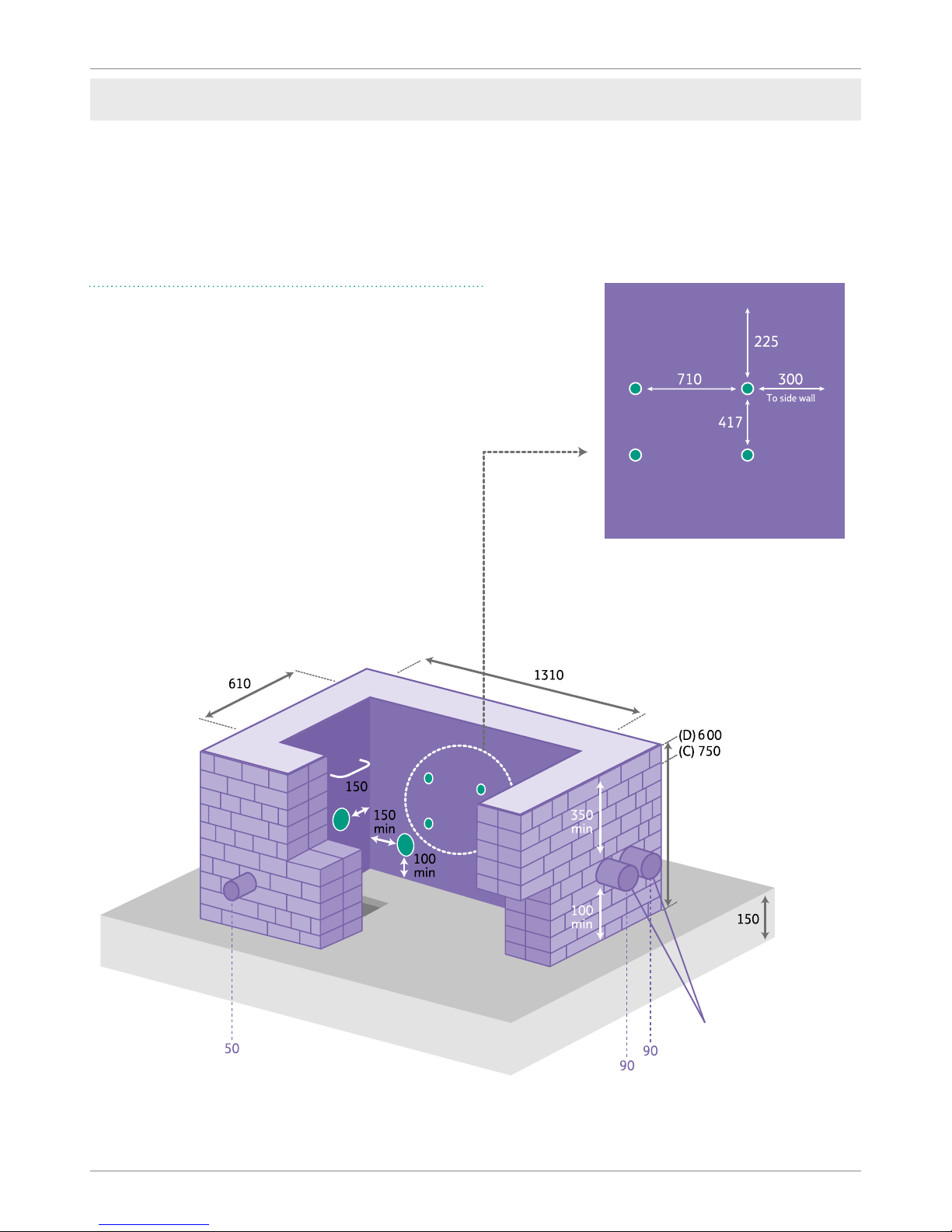

ONT in the default position

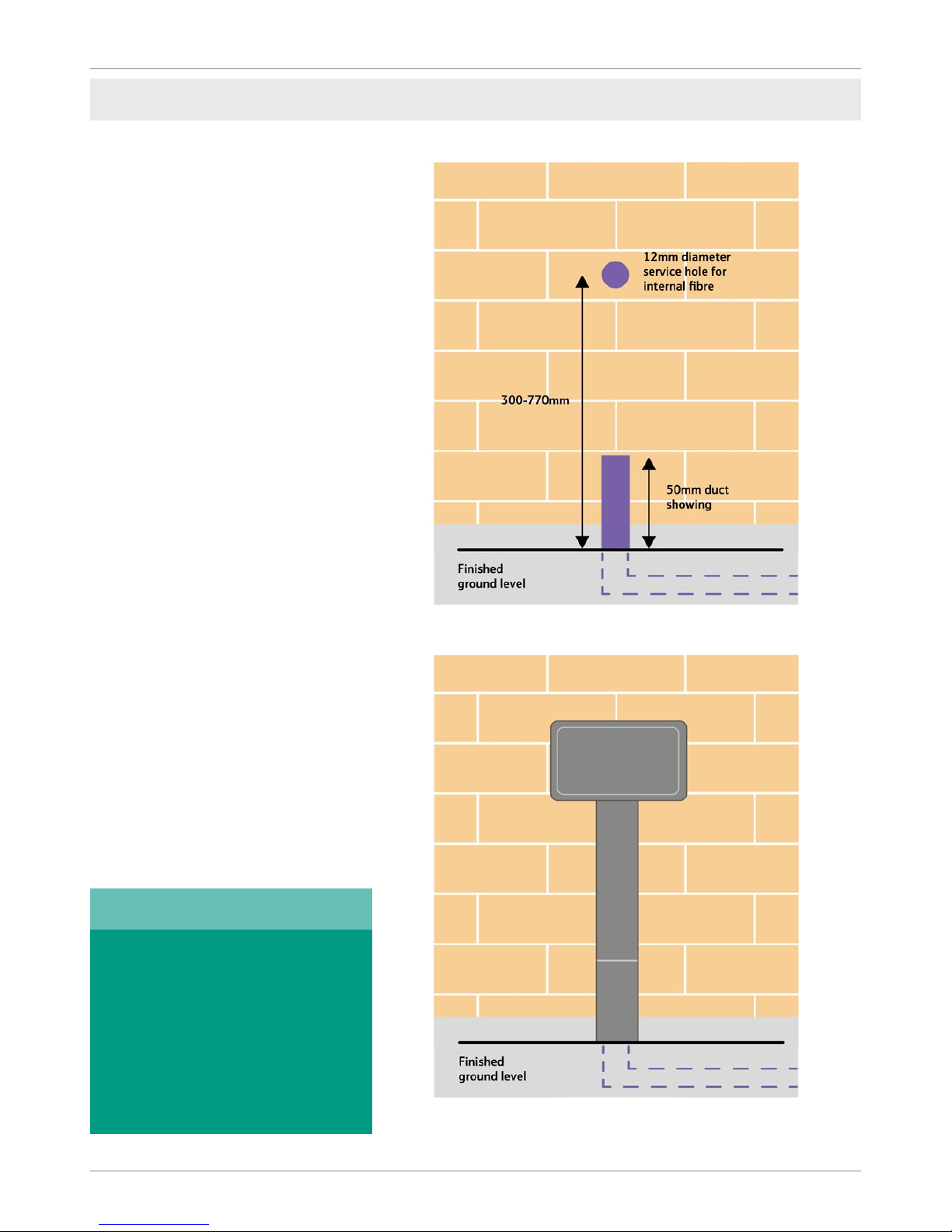

When the ONT is to be tted in the default position on an internal wall directly opposite the entry position of the service access hole adjacent to the external duct location, external capping will be tted on completion.
To keep things tidy, make sure that the service access hole is drilled in line with the duct and in keeping with the dimensions shown below.
The service will be sealed with a grommet or mastic before tting the CSP.
All internal wires and sockets beyond the Optical Network Terminal (ONT) are the responsibility of the developer/future home owner. Any faults or defects resulting in an Openreach visit may incur a charge.
Please note
External presentation by developer
External capping tted by Openreach
Cabling and ONT positioning
How to build a fibre network - version 7.1
Page 16
16
Openreach: Developer Guide
Cabling and ONT positioning

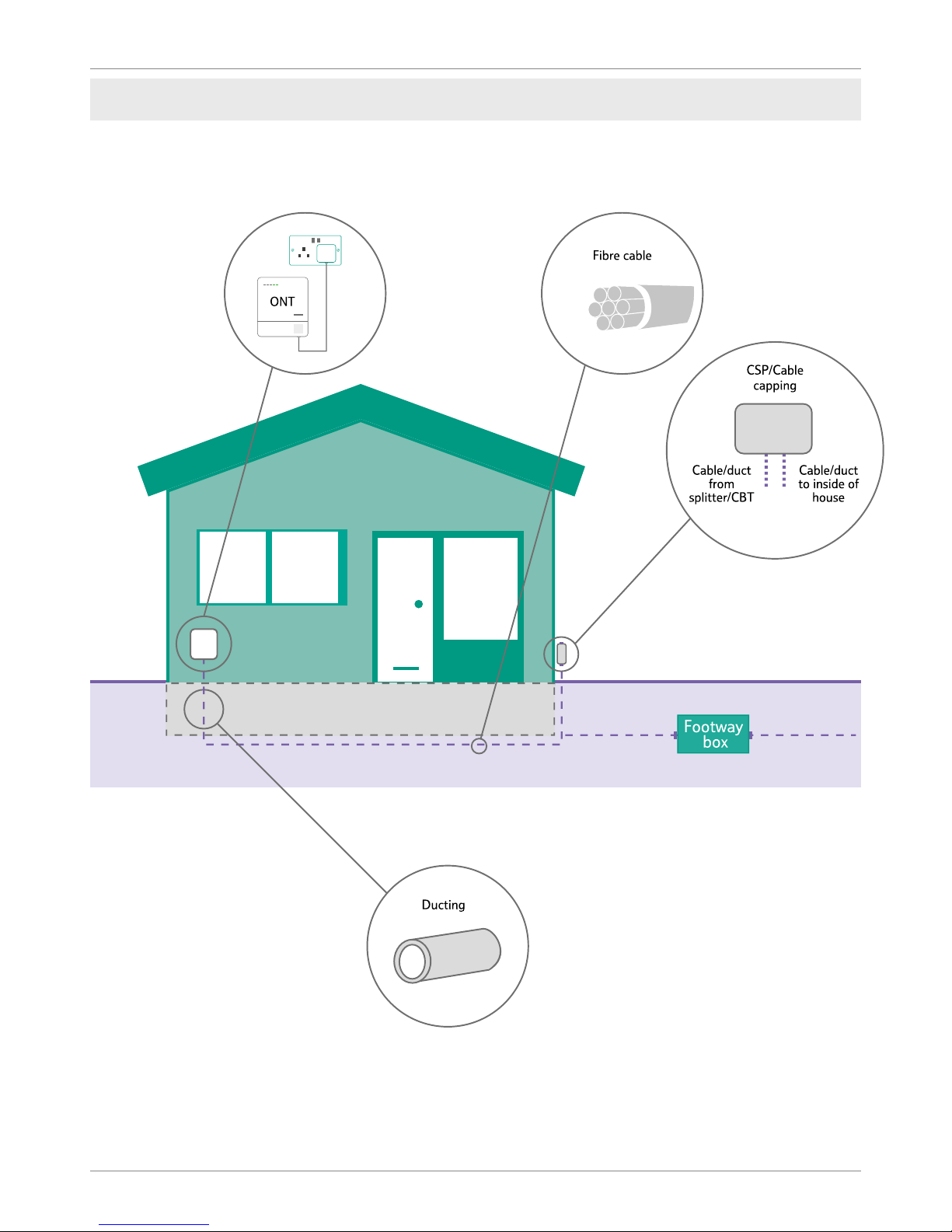

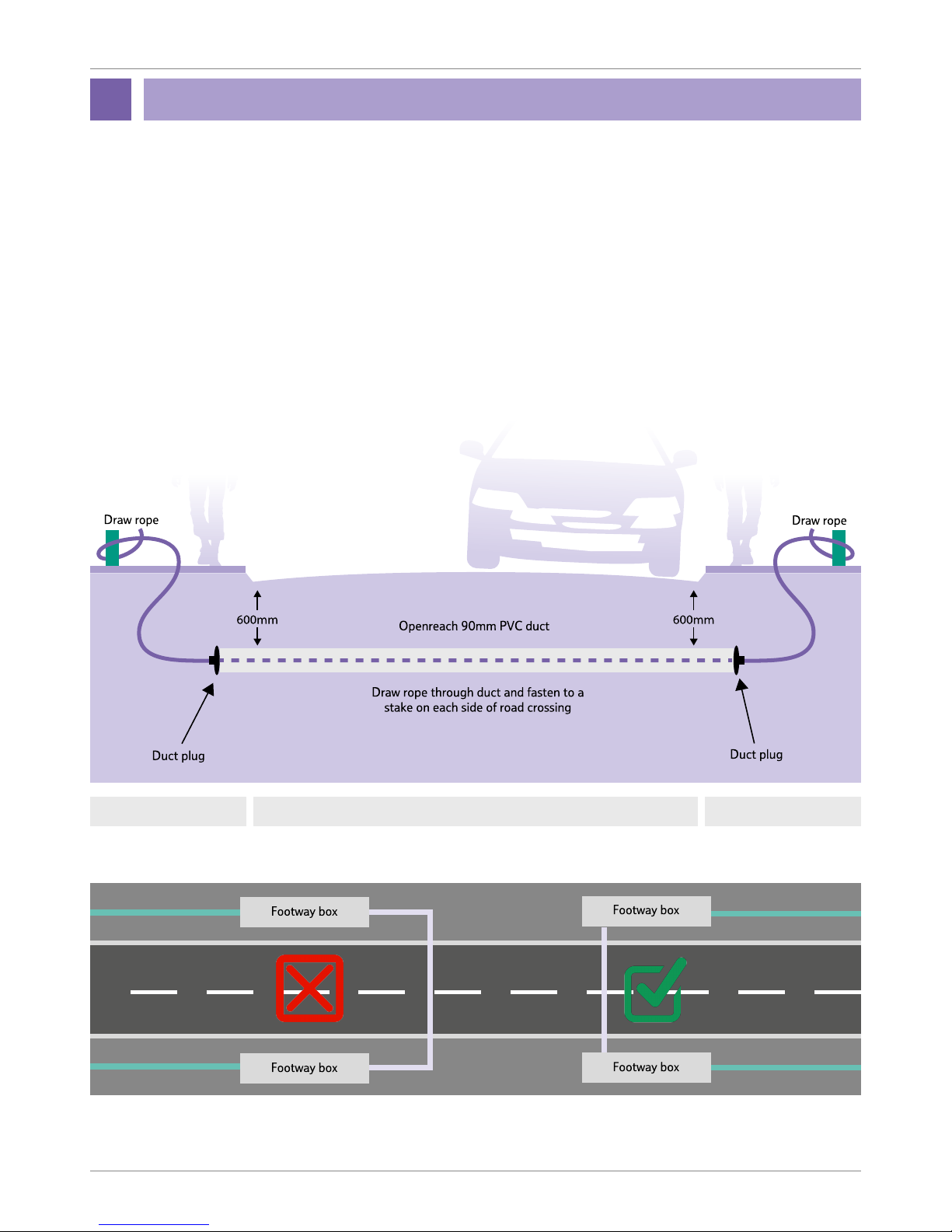

Wherever possible, the duct shall be positioned on the opposite side of the wall to where the ONT will be installed, removing the need to run internal bre cables. However, there are cases where the kit will need to be installed away from the external lead in and your FBC will be able to advise.
When Openreach is to install the Openreach ONT, battery backup and external customer splice point, two metres of cable is required at external end and 1m (or 2m for non­connectorised cable) at the internal point of the installation. It shall be left coiled and housed/protected within a ush mounted double back box and faceplate ready for Openreach provision of ONT and BB.
ONT installed inside the house (non-default position)
When the ONT is to be tted in a non-default position i.e. not directly behind the external CSP, such as in a utility cupboard, the above guidelines shall be followed to provide entry of the cable into the home.
What will be different will be the length of cable that will run from the entry point into the building to the Openreach ONT. In this case you have the responsibility of running the connectorised internal bre cable required inside the house in such a way that it is undamaged and complies with building regulations for the installation of telecommunications infrastructure cabling.
The same rules apply to the running of bre cable internally that are specied in the section on exterior ducting. For example, the installation of the bre cable in protective conduit and the absence of a bend more than 90°.
Once installed the ONT and BBU need to be kept powered on.
If this option is followed but the cable is found to be damaged once in situ, either during installation, damage sustained by construction
work inside the property, or damage subsequent to the home owner occupying the property, then unless you at your expense opt to replace the damaged bre cable during commissioning of the property, then Openreach will install the equipment in the default location within the home using surface mounted cables and charge accordingly.
The developer must run the connectorised internal bre cable in a continuous length and it must remain free from any damage that could reduce the lifespan of the cable.
Interconnecting voice lead (Item Code
077004) will be provided free of charge by Openreach. It provides connectivity from the ONT to a co-located voice socket/patch panel. On installation it becomes the property of the home owner. Alternatively, the developer may choose to hardwire directly into a voice socket using a 431A Plug.
Page 17
17
Cabling and ONT positioning
When Openreach is to install the Openreach ONT, battery backup and external customer splice point, two metres of cable is required at external end of the installation and 1m internally.
It shall be left coiled and housed/protected within a ush mounted double back box and faceplate
(or could be a brushed faceplate if preferred) ready for Openreach provision of external CSP and ONT nearby.
When the developer is installing the Openreach ONT and battery backup 2m of cable is required at the external Splice Point and 1m at the ONT location.
Ensuring re safety with internal cabling
Once ductwork and cable has been run from communications room to splitter – contact FBC to gain conrmation that all cables are run correctly.
FBC will then raise a job with the Openreach Internal teams to commission the splitter(s). Once commissioning is complete contact FBC as each plot is ready for connection (front door on power on, ONT location is decorated).
FBC will then raise a job with the Openreach internal teams to commission the plot(s).

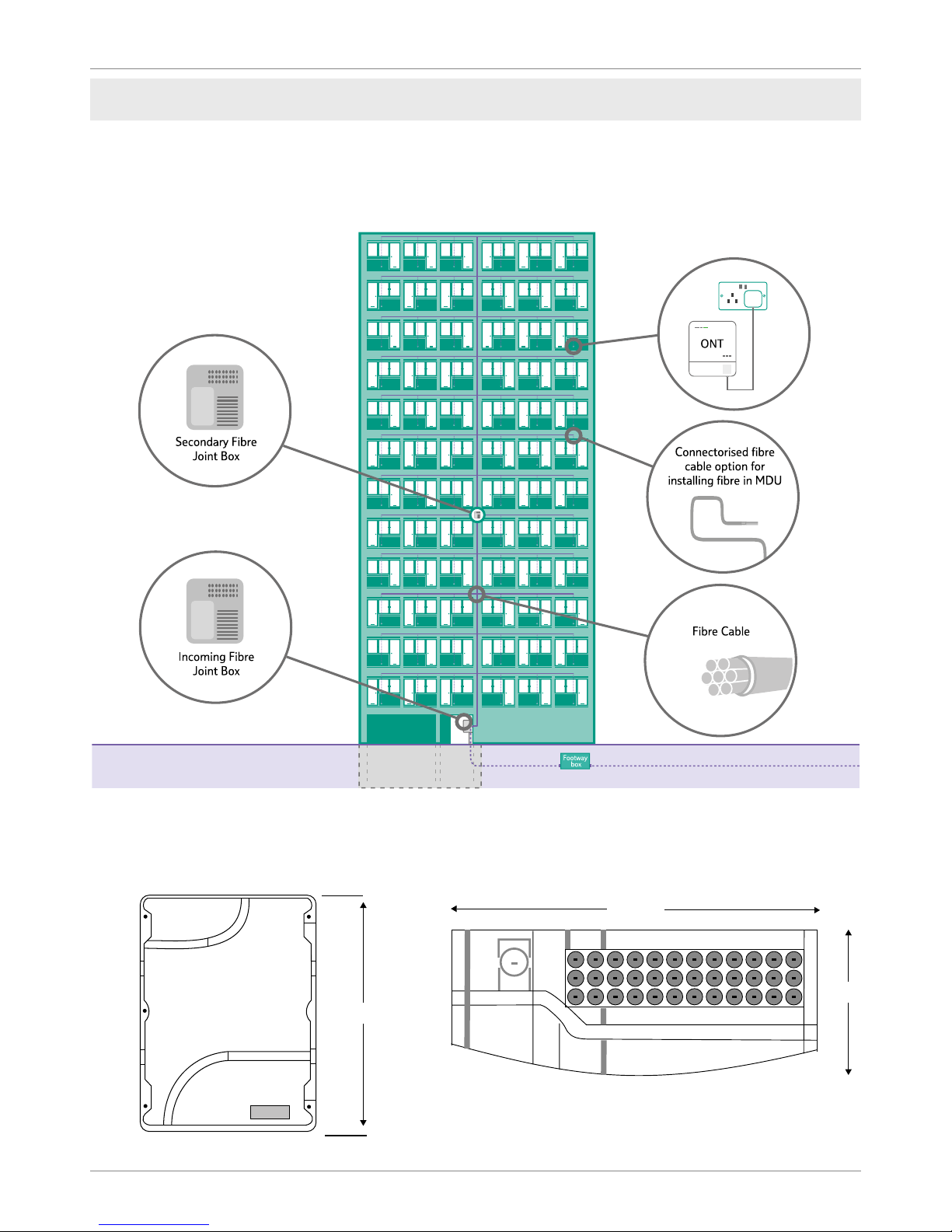

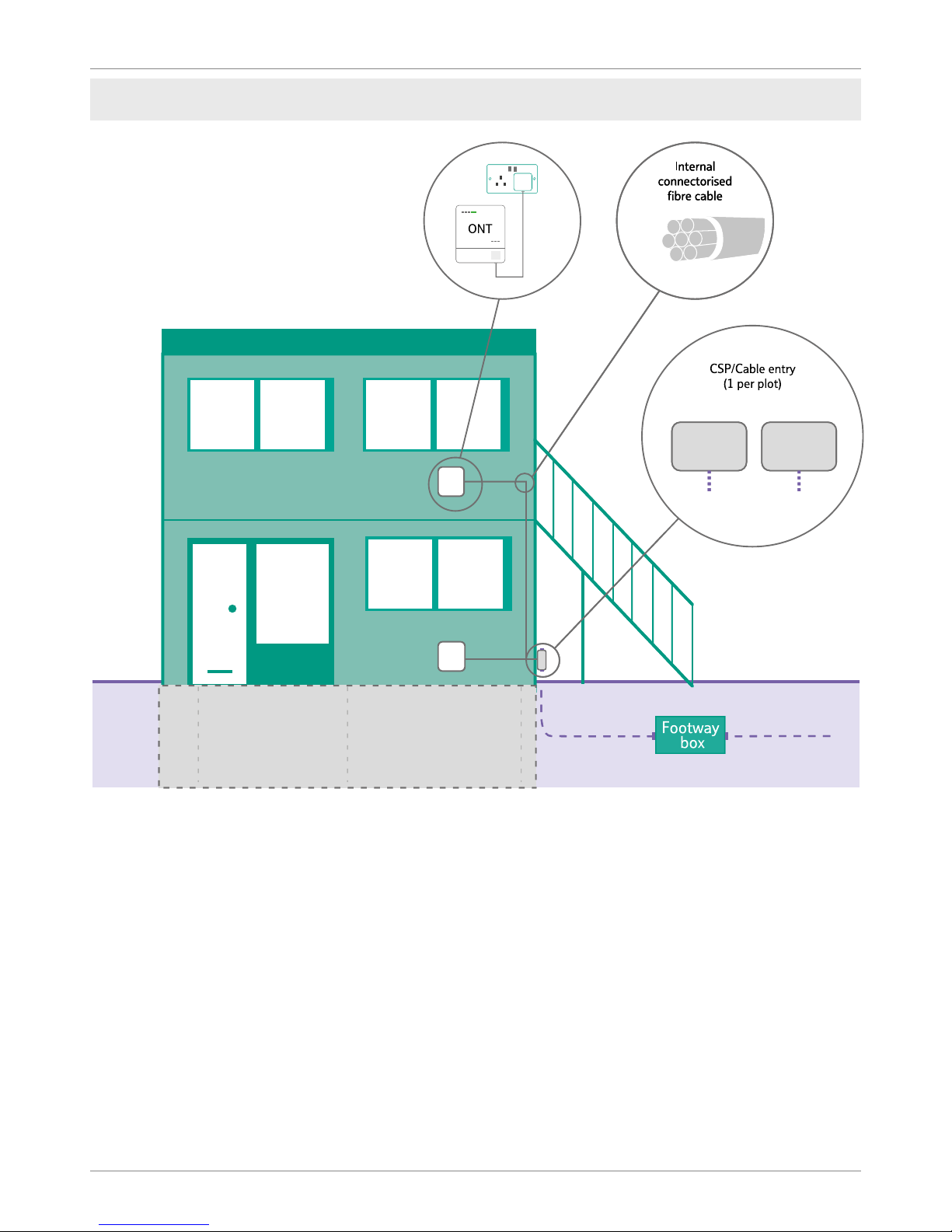

Multiple Dwelling Unit (external)
• Fit all external duct from the site connection point to the building entry position.
• Fit all tray work from the building entry position to and up the risers to the internal splitter position(s).
• Run the bre cable from the splitter location to (and in) the riser to the communications room.
• Coil a minimum of 2m in the communications room.
• Coil a minimum of 2m at internal splitter position.
• Ensuring bend radius of cable must meet all necessary installation requirements i.e. no 90 degree bends (as per current copper process).
• If there is a comms room it has to be within 2m at point of entry.
• If the risers are away from the point of entry but is fed through a vented car park then the external cable can be fed on tray work.
• If the risers are away from point of entry and is fed through a non-vented car park then an area needs to be allowed within 2m of point of entry to change from external to internal cable.
Multiple Dwelling Unit – Next Steps
• Once ductwork and cable has been run from communications room to splitter – contact FBC to gain conrmation that all cables are run correctly.
• FBC will then raise a job with the Openreach Internal teams to commission the splitter(s).
• Once commissioning is complete contact FBC as each plot is ready for connection (front door on power on, ONT location is decorated).
• FBC will then raise a job with the Openreach internal teams to commission the plot(s).
Fire stopping compartment penetrations
All holes drilled through oors and re compartment walls must be re proofed using correct materials to prevent the spread of smoke in the event of a re. Openreach can provide these materials in either cartridge (similar to silicone sealant) or putty form.
How to build a fibre network - version 7.1
Page 18
18
Openreach: Developer Guide
Cabling and ONT positioning
Issues with home wiring
• Connectorised bre cable too short, cut or damaged.
• Defective or damaged home wiring creating a fault on the line.
• Extension sockets not connected to Openreach ONT.
• Bending radii exceeded causing reduced levels of service due to bre being broken or the bend was too tight.
• Incorrect cable type or wiring conguration
Impact on delivery
• Inability for Openreach to provide service and developer requirement to re-provide connectorised bre cable.
• Poor user experience for home purchaser with possibility of Openreach charges if called upon to rectify.
• Slower data download speeds experienced.
• Limit duct runs to a depth of 350mm on footway, 450mm on soft ground or 600mm if shared carriageway surface at house end.
• The Openreach duct shall be no greater than 15mm from the nished wall surface.
• The duct shall protrude no more 50mm from the nished ground level.
• A draw rope must be installed between the joint box and the duct at the property wall.
• The duct opening must be covered, preventing the ingress of debris.
• Ducting from property to the footway boxes shall be laid 4-6 weeks before the plots are handed over.
Fixing cables securely
If you’re running any cables through a re protected area like a re escape route, escape staircase or walkway, the cable must be adequately secured using non-combustible xings. Wiring regulations must be followed, ensuring that wiring systems in escape routes are supported in such a way that
they will not be liable to premature collapse in the event of re. This applies to all cabling and not just electrical cables e.g. alarm, telecoms and control wiring. From January 2019 this will apply throughout the installation as the 18th Edition wiring regulations come into force.
Typical issues with duct presentation
• Duct not cut to the appropriate height from the nished ground level.
• Duct installed too shallow.
• Duct protruding too far from the nished wall surface.
• Duct not lining up with internal bre cable lead in.
Impact on delivery of issues
• Delay in completion – Openreach may refuse to cable if we can’t guarantee adequate protection.
• The capping and covers would look unsightly.
• Failure to provide conduit can prevent a cable from being installed.
• Customers may not be able to place orders and remedial work may incur additional costs.
Page 19
19
Small MDUs (12 or less units)
Openreach will create a bre layout based on your Mechanical & Electrical (M&E) drawings (on larger MDUs) of the MDU. The design will calculate the stores required to build the network.
Your FBC is on hand to guide you through the ordering process to make sure the equipment is available when you need it.

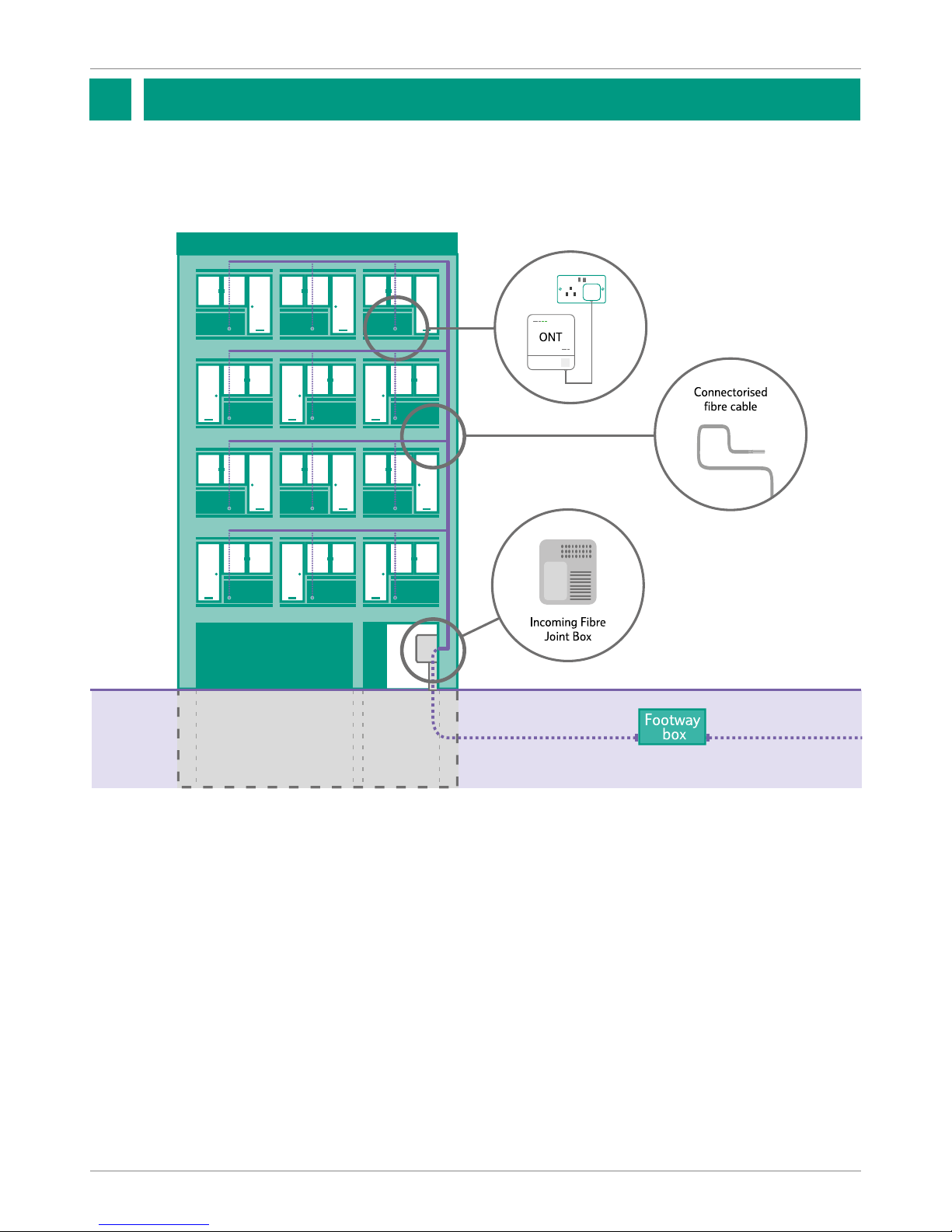

The incoming Duct 54zv and bre cable will terminate in the communications intake room or riser cupboard. This needs to be a secure and safe location with access for installation and any future maintenance visits.
Our bre box/splitter needs to be installed at a minimum height of 200mm and a maximum of 1500mm. Your FBC will agree the location with you.
Connectorised internal bre cable needs to be run from each plot to the bre DP location. A minimum of 3m of coiled cable needs to be left at the bre DP, with 1m left at the plot end.
A wayleave may be required from the building owner prior to installing apparatus in common areas. Remember you may need to order copper, for example: for lift lines.
Multi Dwelling Units (MDUs)
5
How to build a fibre network - version 7.1
Page 20
20
Openreach: Developer Guide
Large MDUs (more than 12 units)
For larger MDUs there may be a requirement to install multiple bre boxes/splitters.
405mm
These boxes/splitters will be connected with Duct 54 and bre cable commonly housed within the riser space.
330mm
120mm
Array of ports for internal bre cable located at bottom of bre DP/splitter
Multi Dwelling Units (MDUs)
Page 21
21
Multi Dwelling Units (MDUs)
Maisonettes
How to build a fibre network - version 7.1
Page 22
22
Openreach: Developer Guide
Multi Dwelling Units (MDUs)
Flat over garage
Page 23
23
Multi Dwelling Units (MDUs)
Chalets
How to build a fibre network - version 7.1
Page 24
24
Openreach: Developer Guide
Multi Dwelling Units (MDUs)
Modular/Passive homes
Page 25
25
Multi Dwelling Units (MDUs)

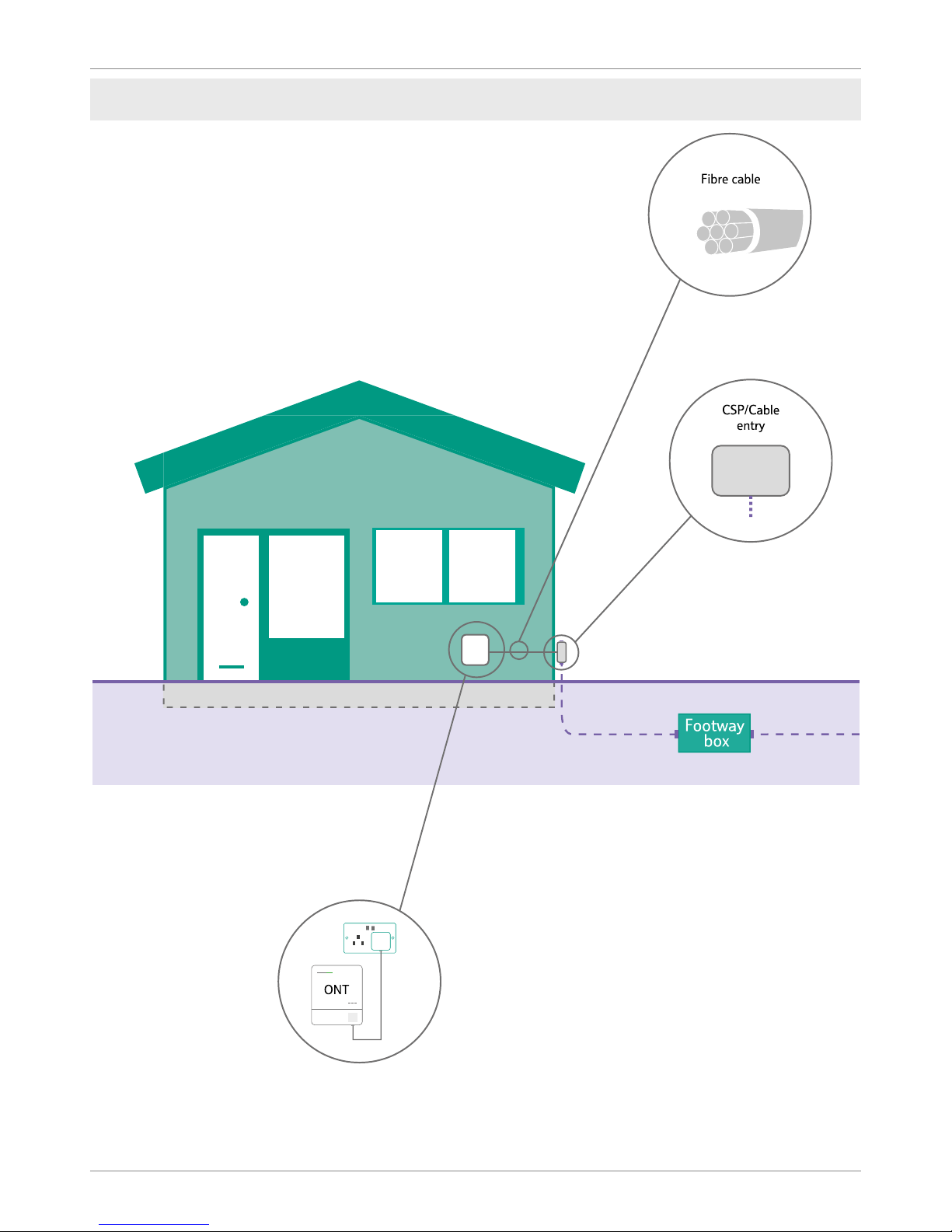

When Openreach is to install the ONT and battery backup, 3m of cable is required at the splitter location and 1m (2m if non-connectorised cable) at the ONT end of the installation.

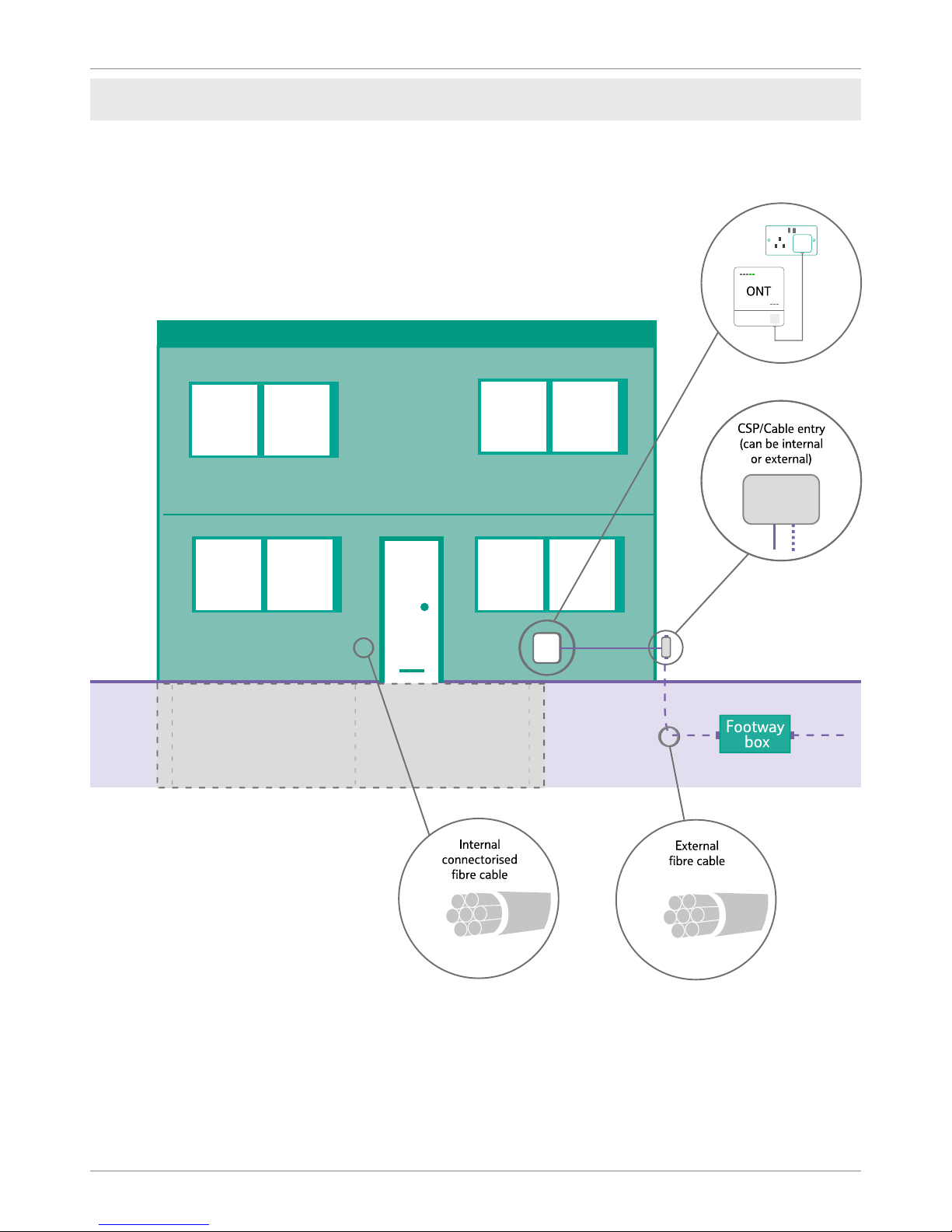

Each apartment will require a designated connectorised internal bre cable run in a continuous fault-free condition from the designated ONT location within the apartment to the splitter box within the riser.
At the splitter locations the cable should be clearly marked with the apartment number and left safely coiled within the riser.

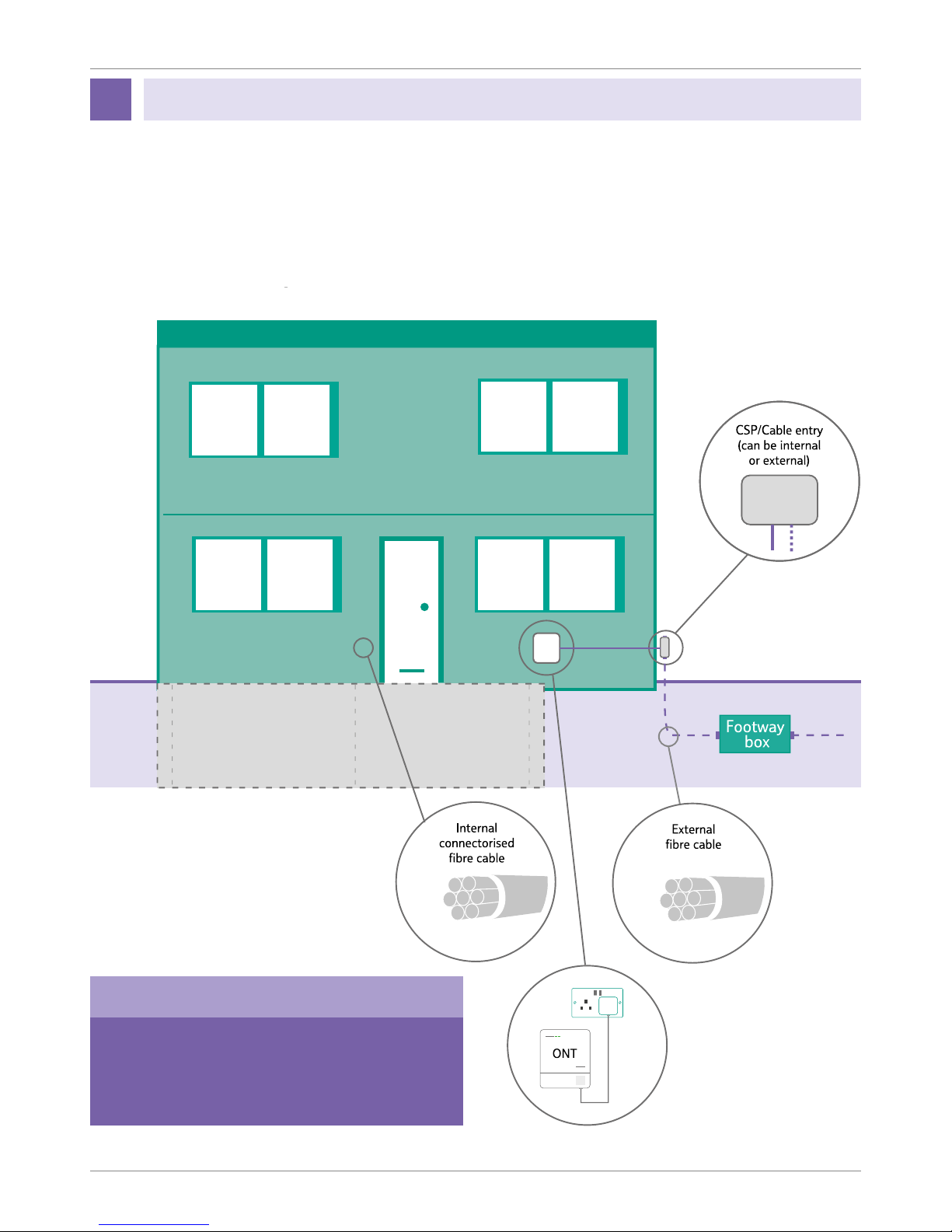

• Install a ush mounted double back box at the desired ONT location.
• Install the connectorised bre cable from this point to the designated riser termination point.
• Ensure there is 1m of spare connectorised bre cable protruding from the back box. (2m if non­connectorised cable)
• Push some of the spare cable back into the wall void and coil the remainder inside the back box, taking care not to damage the connectorised end.
• Install blanking plate or brushed face plate to protect cable ready for provision of ONT nearby.
Option where Openreach installs the equipment
Your FBC will advise of all cable marking/ labelling and will check for this when ‘calling off’ the work.
IET wiring regulations shall be followed.
External cables can run to a maximum of 2m from the internal building entry point.
From this point onwards, all cables must meet current re regulations. The alternative is to house all cables in metallic trunking.
Internal bre cable must not be bent beyond its minimum radius. If it has been damaged or there is evidence of kinking it shall be discarded. Your FBC will advise on replacement of the cable.
Care shall be taken to avoid stretching cable/ tubes through installation. If cables are damaged this way you will be required to replace them.
Bends in bre cable shall be kept to a minimum and the installation of trunking, cable trays/grids shall not compromise the bending radii.
Fibre cable containing no metal parts can be run on shared trays.
Plate cable xings with cable ties must be used to x bre cable direct to walls to avoid it being damaged.
Under no circumstances shall cable or tubing be secured or supported to the suspended ceiling hangers or under oor support legs.
It is the developer’s responsibility to provide re stopping on completion of the cable/ tubing installation.
Openreach networks must not interfere with or be interfered with by other services within the riser or any other shared space. e.g.
• Un-insulated hot water pipes.
• Unscreened mains cables.
• Fluorescent lighting.
• Heavy duty switch gear.
A wayleave may be required from the building owner prior to installing apparatus in common areas.
Remember you may need to order copper lines for commercial properties, for example lift lines.
How to build a fibre network - version 7.1
Page 26
26
Openreach: Developer Guide
Small or Medium Enterprise (SME) unit on a residential development
Commercial units
6
The ONT position within the building is to be agreed between the FBC and the developer on site.
Please note
Page 27
27
Commercial units
SME within an MDU
How to build a fibre network - version 7.1
Page 28
28
Openreach: Developer Guide
Commercial units
Commercial unit within a commercial only site
Page 29
29
Where our duct crosses a carriageway, adjoining kerbs must be temporarily marked to note positions.
Openreach duct shall be laid on an outer edge of the service trench to enable box building. A draw rope shall be inserted through the duct and secured to the marker posts at both ends of the crossing.The appropriate Plug Duct 4B socket end and 4C Spigot shall be tted.
Duct laid beneath a carriageway crossing must be 600mm depth from the cover of the nal surface levels and, for engineering reasons (National Joint Utilities Group NJUG), separated from other services laid in parallel by 600mm (to permit us to install underground joint boxes without the need for bends).
Carriageway Road Crossings
Footpath Carriageway Footpath
Duct laying
7
How to build a fibre network - version 7.1
Page 30
30
Openreach: Developer Guide
Ducting to the building
Duct to the premises/building must be laid at a minimum depth of 350mm and be as straight as possible.
The latest information on the positioning of utilities, mains and plant can be obtained from the National Joint Utilities Group: www.njug.org.uk
Please note
Ducting general principles
• All runs shall be laid as straight as possible. If needed, you can carefully bend the ducts or use pre-formed bends supplied by Openreach.
• There shall be no more than one pre-formed 90° bend in any single run of duct.
• Pre-formed 90° bends shall not be installed in any duct linking two joint boxes.
• Footpath or service strip ducting must be laid at 350mm depth of cover.
• All space alongside the duct must be backlled with granular ll to a minimum thickness of 75mm.
• For all Single Dwelling Units (SDU) duct must be terminated on the external surface of the property.
• The duct termination point shall be in a location that will allow unrestricted access for any future maintenance activity.
• All ducts must be provided with a draw rope after installation, unless it’s agreed locally to substitute the draw rope with a cable.
• Please notify your FBC when the duct has been laid and is ready for inspection.
Commercial unit ducting
• 90mm duct can be laid either externally or internally to the building, with 45 degree angled bend.
• If internally then the duct should be sealed once cabling is complete – the FBC will provide this as a stores item.
• The termination point on a large commercial unit within a commercial only site should be located within 10m of the entry point.
Duct laying
Page 31
31
Duct laying
Recommend depth of utility apparatus
1
2
3
4
5
Footpath Carriageway
Arrangement of mains services
Electricity / HV 450 to 1200mm / LV 450mm
Cable TV and Communications / 250 to 350mm
Gas 600mm
Water 750mm
Telecommunications 350mm
How to build a fibre network - version 7.1
Page 32
32
Openreach: Developer Guide
Duct laying
Openreach has an extensive underground network that can be located inside / on the perimeter of a site. This network is vulnerable to excavation related damage unless appropriate precautions are taken. The precautions for avoiding damage to an underground utility plant are contained within the Health & Safety Guide no. 47: “Avoiding danger from underground services”. This document stresses the need for the availability of utility plans on site and the use of safe digging practices.
Available here:
www.hse.gov.uk/pubns/books/hsg47.htm
Typical issues with carriageway road crossings
• Insufcient depth.
• Proximity to other services.
Impact of issues
You will have to renew duct and this may delay any rst occupation date or subsequent occupation dates.
Damage to the Openreach network by a third party can be expensive for that party to repair. By working together, we want to make sure you avoid the repair and associated cost which can consist of one or more of the following:
• Direct Cost – the cost of repair.
• Operational Cost – delays associated with repair.
• Social Cost – loss of service to emergency services/ centres or the vulnerable in society.
Avoiding damage to the Openreach underground network
To obtain a more precise location of Openreach
infrastructure (either within your site or the adjoining land)
and avoid costly damage, contact:
Click Before You Dig
Utilisation of the Openreach “Click Before You Dig”
free service has a proven record of minimising the potential
for damage and cost.
If you need to move or consult on existing
Openreach equipment, contact us on
0800 783 2023 or complete the online webform at
www.ournetwork.openreach.co.uk/help-and-support.aspx
Page 33
33
The optional approved pre-formed chamber system Quadbox™ can be used to speed up the installation process and bring signicant productivity benets as there is no need for specialist box building teams and concrete backll to be used.
The Quadbox™ is not a free stores item from Openreach, but can be purchased directly from our approved supplier, Cubis Industries:
www.stakkabox-quad.com
Joint box modular footways 104 and 106 are the Openreach approved versions (BT specication LN178).
Box furniture items slot into moulded pockets within the chamber, eliminating the need to cast­in xings or drill on site. Duct entries are also easy to achieve, using a standard hole saw mounted on a cordless drill.
The lightweight high-strength system is supplied as 150mm deep twin wall high-density polyethylene (HDPE) rings to provide maximum exibility and strength which are simply stacked on a prepared base and backlled with suitable as-dug or Type 1 material. See the suppliers Installation Guide Which comes with your box.
If purchasing a pre-formed chamber you are required to purchase the associated furniture.
Modular jointing chambers – Quadbox
TM
8
How to build a fibre network - version 7.1
Page 34
34
Openreach: Developer Guide
Furniture
Cable brackets and steps (where required) are supplied in a bagged kit and easily slot into purpose designed pockets in the chamber. The brackets and steps drop into preformed slots.
Available Size Range
Product Code Clear opening
Depth Per
Section
JMF104 915X445mm 150mm
JMF106 1310X610mm 150mm
Duct entries
Duct entries can be cut as and where required using a hole saw mounted on a cordless drill.
The chambers incorporate guides which identify drilling points to ensure correct duct spacing.
A maximum of 4 duct entries can be made into a single wall of the Quadbox™.
Quadbox points of note
As with brick built chambers, care should be taken to make sure:
• The box is set at the correct depth and the base/ plinth is installed correctly.
• The side wall is not damaged/misshapen due to over compaction.
• The frame is level with the surface and a core drill is used for cutting duct entries.
• The developer is required to purchase the required wall bearers
Modular jointing chambers – Quadbox
TM
Page 35
35
Joint box designs and specications may vary depending on the duct layout and whether multi-way ducts or major road crossings need to be incorporated into the network design.
Full technical drawings and specications are available at www.openreach.co.uk/propertydevelopments

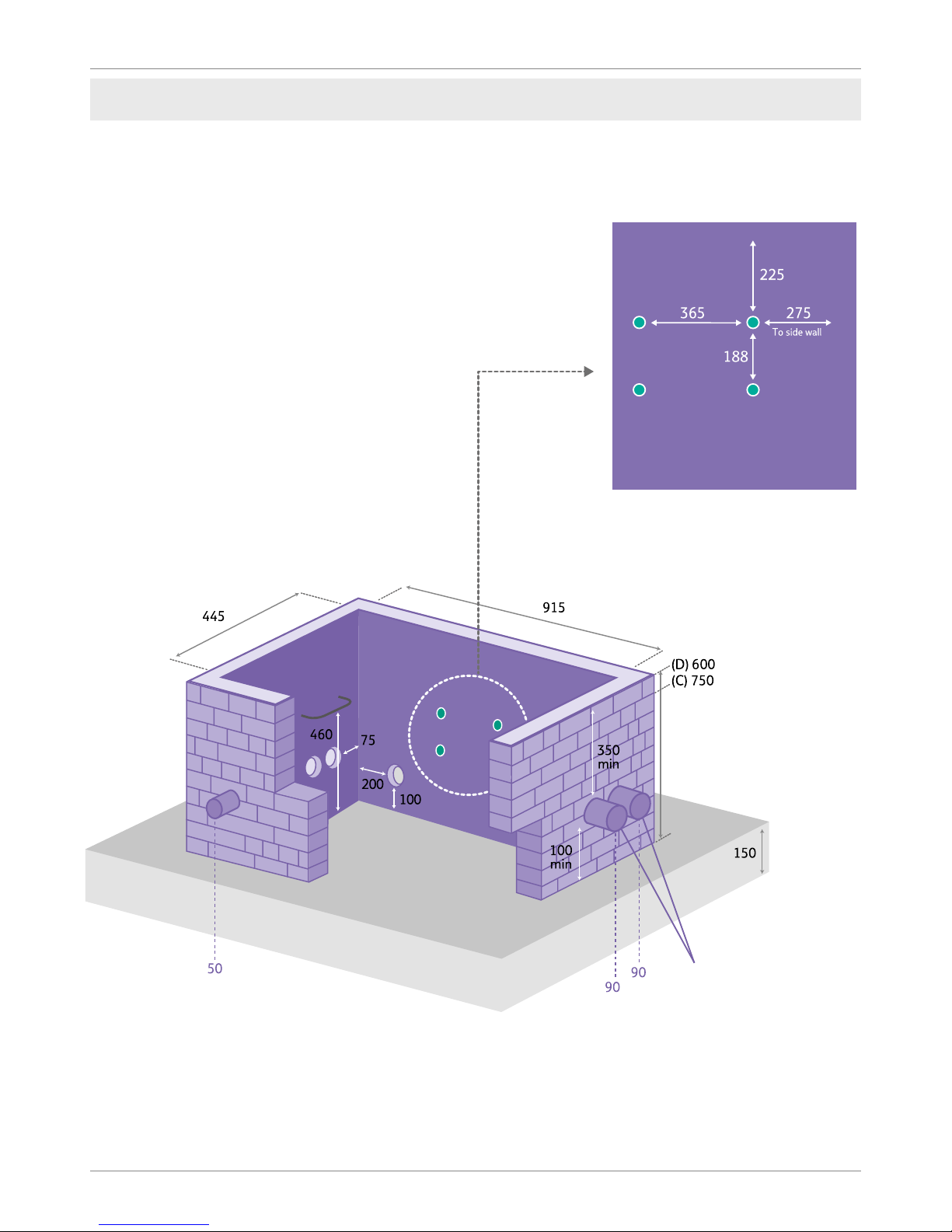

Footway (JBF104/106)
Materials
• Bricks: BS EN771-1. Stretcher Bond.
• Cement: BS EN197-1:2000 ordinary mix.
Three parts sand to one part cement.
Specications
• Base: 150mm concrete, clean and level.
• Brickwork: Keyed in at the corners
and pointed.
• Frame and cover: Set on a mortar bed and
fitted squarely to the box structure. You can purchase lifting keys for the covers from TW Engineering Co Ltd at www.twtools.co.uk (tel: 0115 932 3223).
• Duct entries: Must not enter through corners
and be no less than 75mm from the side wall. They shall enter wall at a minimum depth of 350mm from the top of the frame, cut flush and clear the base by a minimum of 100mm.
• Bolts: Must be fitted in each box to allow
ironwork to be installed by the developer.
• Step(s): One step is required in all boxes
deeper than 700mm.
• JBF104(C): 915mm(L) x 445mm(W) x
600mm(D).
• JBF104(D): 915mm(L) x 445mm(W) x
600mm(D) the minimum depth for boxes either side of road crossings.
• JBF106(C): 1310mm(L) x 610(W) x 600(D).
• JBF106(D): 1310mm(L) x 610(W) x 600(D)
the minimum depth for boxes either side of road crossings.
• All backll material to be class 6N type.
• Workmanship, materials and method of construction are to comply with all current relevant contract documents, British Standards and codes of practice for the construction industry.
• Concrete to be grade C32/40 with a water cement ratio 0.4 minimum. Cement content 380kg/m3. Aggregate maximum size 20mm. All in accordance with BS8500.
• All ducts shown are based on maximum recommended values for Duct Type 54D.
• End ducts to be inline.
• Ducts to be positioned not less than 75mm from a side wall.
• Mesh to be grade B500B or B500C conforming to BS4483.
• Short lengths of Duct 54D 90mm to be used on non-ducted routes. Appropriate duct to be used on ducted routes.
• Where instructed to do so drill one set of three holes using a 12mm masonry drill bit to a depth of 80mm for future tting of equipment mounting bracket.
• For details and specs on using corbelling visit the link at the top of this page
At no time must minimum box depth be compromised. Consult your FBC if the minimum depth cannot be achieved.
Please note
Joint boxes, footways and frames & covers
9
How to build a fibre network - version 7.1
Page 36
36
Openreach: Developer Guide
Concrete base
Bolts foundation for wall bearer/brackets
Duct
Joint box footway 104 – the preferred option
Internal dimensions. Brickwork Stretcher Bond.
Dimensions in mm (not to scale).
Joint boxes, footways and frames & covers
Page 37
37
Concrete base
Duct
Joint box footway 106
Internal dimensions. Brickwork Stretcher Bond.
Dimensions in mm (not to scale).
• Minimum depth for road crossing 900mm
• Sump to be tted in boxes deeper than 700mm
Bolts foundation for wall bearer/brackets
Joint boxes, footways and frames & covers
How to build a fibre network - version 7.1
Page 38
38
Openreach: Developer Guide
Joint boxes, footways and frames & covers
Carriageway JBC4
Box design and specications may vary. This will be determined by the duct lay-out and whether multi-way ducts or major road crossings need to be incorporated into the design.
Materials
• Bricks: BS EN771-1. English Bond.
• Cement: BS12 Portland Cement.
• Concrete: BS EN206 Grade 32/40 concrete.
• Mortar: BS5628, Part1 requirement for mortar Table 1, Type (i).
Base
• Cement: BS12 Portland Cement.
• Concrete: 200mm concrete Grade 32/40, reinforced with A393 grade mesh at 70mm cover.
Brickwork
• Bricks: BS EN771-1. English Bond.
• All brickwork to be keyed in at corners and pointed.
• Brickwork to be ‘English Bond’ constructed with a 10mm joint thickness of cement mortar.
Frame and cover
• Frame and Cover Carriageway no.4 to be squarely set on a mortar bed Highway Agency standards HA104.
Lifting keys
• Key Joint Box Lifter should be used to lift the cover and can be purchased from TW Engineering Co Ltd at www.twtools.co.uk (tel: 0115 932 3223) or similar supplier of your choosing.
Duct entries
• Duct to be cut ush to the internal box wall.
• Duct must not enter through corners and be no less than 75mm from the side wall.
• Duct to enter wall no less than 600mm from the top of the frame.
• Duct to be no less than 100mm from the box base.
Bolts foundation for wall bearer/brackets
Concrete base
F
or use with carriageway no.4
frame and cover
A393 Mesh 950x950
Page 39
39
Joint boxes, footways and frames & covers
Frames and Covers
Cubis Industries is the only supplier of these Openreach approved products
Only approved frames and covers shall be tted on your site. They are identiable by the following markings; ‘EN24 B125’ the British Standards kitemark the Manufacturer Mark (SID), the year of manufacture and the BT identier.
The ‘standard frames and covers’ are supplied by Openreach. They consist of a galvanised steel fabricated frame, tted with unlled galvanised steel fabricated cover trays and cross-beams.
All covers can be tted to brick or concrete.
Where there’s evidence or high risk of vehicles using the soft verge e.g. as an undertaking area opposite a T-Junction, a passing point on a narrow road or a parking area, it will be necessary to install a ‘carriageway chamber, frame and cover’.
There is also an optional ‘recessed frame and cover’
Please note
Recessed frames and covers
These can be purchased by the installer as an option to the ‘standard frame and cover’.
Each cover tray has two key-hole ttings (in the centre of the short side) one of which carries a BT identity mark and the manufacturers’ three letter identication ‘SID’. The other key-hole tting displays EN124 and B125 together with the BSI Kite mark certifying the covers to BS EN124: 1994.
Recessed frames and covers will accommodate inll blocks to a maximum depth of 60mm.
If you’re planning to install frames and covers that aren’t supplied by Openreach e.g. for block paving, or you have any doubts about what frames and covers to use, please speak to your FBC.
How to build a fibre network - version 7.1
Page 40
40
Openreach: Developer Guide
Joint boxes, footways and frames & covers
Installation
All frames and covers shall be levelled to the nal running surface.
Where a box is located within a grass, soft or unmade surfaces, the frame shall be surrounded with a 100mm wide strip of minimum grade C25/30 concrete, to the full depth of the frame, nished level with the top edge of the frame and the outside edge. It must be straight and parallel to the frame.
Unapproved frames and covers
Unapproved frames and covers must not be tted. Openreach will take any necessary action against any developer who ts unapproved frames and covers within the network, including any potential claim for damages and costs, with possible delayed Service On Demand (SOD) payments.
If you’re unsure how to specify approved covers, please contact your FBC.
Page 41
41
BBU BSI BT CLI CP CSP DP FDP FTTP FBC HDPE
IET
JBC (N) JBF LSZH MDU MJF M&E NJUG NTE NTP ONT PAS PE PVC RFH SID SDU SOD UG
Openreach maintains that all reasonable care and skill has been used in the compilation of this publication. However, Openreach shall not be under any liability for loss or damage (including consequential loss) whatsoever or howsoever arising as a result of the use of this publication by the reader, his servants, agents or any third party.
In the event of a discrepancy between the contents of this document and the contract, the terms and conditions shall take precedence. This is a living document and will be subject to update and change. The information within this document is provided for information purposes only. The Contract and Price List take precedence.
Battery Backup Unit British Standards Institute British Telecommunications Customer Lead In Communications Provider Customer Splice Point Distribution Point Fibre Distribution Point Fibre to the Premises Field Based Coordinator (formally New Site Representative) High-Density Polyethylene Institute of Engineering and Technology Joint Box Carriageway New Sites Joint Box Footway Low Smoke Zero Halogen Multiple Dwelling Unit Product code designation for the Cubis Industries–StakkaBox/Quadbox Mechanical & Electrical National Joint Utilities Group Network Terminating Equipment Network Terminating Point Optical Network Termination Publically Available Specication Polyethylene Polyvinyl Chloride Reduced Fire Hazard Manufacturers three letter identication Single Dwelling Units Service on Demand Under Ground
List of abbreviations and acronyms
10
How to build a fibre network - version 7.1
Page 42
42
Openreach: Developer Guide
This guidance is a practical aid for designers and site workers on what to eliminate, avoid and consider when working on the Openreach network on your site.
The advice is not exhaustive so speak to your Field Based Co-Ordinator (FBC) if you need further information.
Red lists
Hazardous procedures, products and processes that should be eliminated
from the project where possible.
Distribution point (DP) location
• Placing DPs into voids or other enclosed spaces with inadequate ventilation
• Placing DPs adjacent to, or above, any fragile surface
• Placing DPs directly above, or adjacent to, water features / courses etc
• Locating DP at greater than 1.5 meters above nished oor level (without xed access system incorporated into design)
Cabling routes and lead-ins
• Routing of cables where the cables are above head height within false ceiling systems without a proper access system incorporated
• Routing of cables external to building requiring specialist access methods (scaffold, mobile elevating work platform etc.)
• No internal ducting laid into Single Dwelling Units (SDUs)
Power systems
• Ensure all power installation meet relevant standards, and where DC supplies are planned seek further advice about requirements for earthing of racks, power supply ratings etc. to take account of future needs and growth
Aerial and antenna transmission / receiver systems
• Not mounted on building walls or other difcult to reach areas of a building
• Design of roof mounted services that require access (for maintenance and so on), without provision for safe access (such as barriers) in particular access for aerials / antennas systems.
Health and safety advice
11
Page 43
43
Amber lists
Products, processes and procedures to be eliminated or reduced as
far as possible and only specied or allowed if unavoidable.
Including amber items would always lead to the provision of information to the
principal contractor or contractor where only one contractor has been appointed.
Distribution point (DP) location
• DP’s located into voids or enclosed spaces provided with ventilation systems built in
Cabling routes and lead-ins
• Routing of cables where the cables are above head height within false ceiling systems
• Routing of cables internally where access points require use of access equipment (ladders, step-ladders or platform steps) to allow for pulling in of cables
Aerial and antenna transmission / receiver systems
• EMF exclusion zones adequately managed with xed barriers or partitioning systems.
Health and safety advice
How to build a fibre network - version 7.1
Page 44
44
Openreach: Developer Guide
Health and safety advice
Green lists
Products, processes and procedures to be positively encouraged.
• Adequate access for vehicles to minimise reversing requirements (one-way systems and turning radii) in particular if specialist vehicles will need access (pole erection units, MEWP vehicles etc.).
• Provision of adequate access and headroom for maintenance in communications rooms, and adequate provision for replacing heavy components.
• Thoughtful location of mechanical and electrical equipment, such as telecoms equipment, termination points, Wi-Fi transceivers etc. and so on to facilitate access, and placed away from crowded areas.
• Lighting within communications rooms adequate for ne tasks (bre splicing, small diameter copper wire terminations etc.)
• Provision of adequate air handling / conditioning and ventilation for the installed equipment base within the communications room (and people having to access and work within the area)
• Early installation of permanent means of access, and prefabricated access systems with hand rails.
• Provision of edge protection at permanent works where there is a foreseeable risk of falls after handover (consider radio antenna or aerials installations on roof spaces).
• Encourage the use of engineering controls to minimise the use of personal protective equipment.
Page 45
45
Quality control checklist
12
To help make sure your site network is built to a high quality standard, we’ve produced a checklist for each phase of the build.
Any subsequent changes to the site plan after a checklist has been completed must be communicated and agreed with your FBC as soon as possible.
Any re-work as a result of an out of date site plan could cause delivery delay and incur you costs in time related charges.
The Site
Developer
Site Name
Post Code
Site Manager/ Developer Agent Name
Telephone
Email
Site Address
Openreach New Site Identity Ref
The Site Manager/Developer Agent agrees to the quality standards and conditions.
Signature:
Date:
If you have any questions about your development, please visit www.openreach.co.uk/propertydevelopments or call us on 0800 783 2023
New Sites Ofce
FBC Name
Telephone
Email
Off-site Connection Location
First Occupation Date
Site Start Date
Openreach Contact
How to build a fibre network - version 7.1
Page 46
46
Openreach: Developer Guide
Quality control checklist
Base has been cast correctly Joint Box
Reinforced base cast correctly for Joint Box Carriageway JBC (N).
Joint Box
Bearers and brackets tted. Steps tted where appropriate.
Joint Box
Bolts tted and positioned correctly during construction of boxes.
Joint Box
Joint Box constructed to correct dimensions and installed at the correct depth. Any deviations to plan recorded and signed off.
Joint Box
All concrete/brickwork carried out as per developer ‘How to’ guide specication.
Joint Box
Cement and brick types used as specied or exceptions agreed and documented.
Joint Box
Frames and covers bedded and correctly installed (if unmade surface, Joint Box frame secured).
Joint Box
Joint Box constructed as planned, positioned correctly and conforms to drawings. Alternatives agreed and documented.
Joint Box
Modular box installed and prepared as per instructions.
Joint Box
Ducts properly trimmed and keyed when set in walls.
External cable/Blown Fibre Tubing (BFT) protected and sealed in Joint Box.
Joint Box
Joint Box
Item being audited Category
Yes No N/A
Checked and Acceptable Standard?
Comments
Page 47
47
Fibre cable and draw rope provided in sound condition and correctly jointed where applicable.
Duct
DuctCable/BFT left in planned location.
Correct rope/cables/tubing installed as per Developer ‘How to’ guide.
Correct type of duct provided and used.
Duct laid in required position, at correct depth and installed in the correct position in the Joint Box.
Duct properly trimmed and keyed when set in walls.
Duct separation distance maintained, or exception agreement obtained and documented.
Ducts laid at minimum depth (350mm), or exceptions agreed and documented. (To be viewed in footway where possible, if not check via Joint Box).
Joint Box constructed as planned, positioned correctly and conforms to drawings. Alternatives agreed and documented.
Temporary duct seals tted to agreed standard.
Ducts positioned correctly on external walls and in line with the cable entry point.
Item being audited Category
Yes No N/A
Checked and Acceptable Standard?
Comments
Duct
Duct
Duct
Duct
Duct
Duct
Duct
Duct
Duct
Quality control checklist
How to build a fibre network - version 7.1
Page 48
48
Openreach: Developer Guide
Quality control checklist
Plot
Ducts positioned in line with the cable entry point.
Plot
Customer cable entries correctly positioned and provided.
External cable/BFT protected and sealed.
Plot
Duct seal Plug 1A tted.
Plot
Back box installed at entry point.
Back box tted at a usable depth, within close proximity to a double 240v outlet for FTTP services.
Plot
The property has been designed to accommodate voice and data wiring in a convenient place for home owners to use FTTP services.
A permanent 240 volt supply is required for FTTP. Developer has been informed that no orders can be made or taken via a Service Provider until all installation works of Openreach equipment into each plot has been completed and tested.
Item being audited Category
Yes No N/A
Checked and Acceptable Standard?
Comments
Plot
Plot
Location of unit entry point suitable for FTTP equipment.
Plot
Plot
Voice and data cabling provided and terminated correctly for FTTP services.
Plot
If FTTP self install development ONT, BBU, all leads connected correctly and plot commissioned.
Plot
If self install not completed and Openreach completes all internal work then SOD payment for self install is not applied
Plot
Page 49
49
All tubes or cables presented as per schematic diagram and capped.
Multi
Dwelling Unit
Designated track ways/trays supports in good working order with separations maintained.
Connectorised bre cable installed as per schematic in accordance with Manufacturer’s specications and IET wiring regulations. Cable labelled and coiled safely within riser.
Connectorised bre cable installed with 1m of spare length protruding from the back box to enable jointing.
Back box tted in each unit at a usable depth, within close proximity to a double 240v outlet for FTTP connectivity.
Location of unit entry suitable for FTTP equipment.
If FTTP self install development ONT, BBU, all leads connected correctly and plot commissioned
If self install but Openreach completed all internal work then SOD payment for self install is not applied.
Item being audited Category
Yes No N/A
Checked and Acceptable Standard?
Comments
Multi
Dwelling Unit
Multi
Dwelling Unit
Multi
Dwelling Unit
Multi
Dwelling Unit
Multi
Dwelling Unit
Multi
Dwelling Unit
Multi
Dwelling Unit
Quality control checklist
How to build a fibre network - version 7.1
Page 50
50
Openreach: Developer Guide
Notes
Page 51
bre
network
How to build a
Page 52
www.openreach.co.uk
The telecommunications services described in this publication are subject to availability and may be modied from time to time. Products and services are provided subject to British Telecommunications plc’s respective standard conditions of contract. Nothing in this publication forms any part of any contract. Openreach and the Openreach logo are trademarks of British Telecommunications plc.
© British Telecommunications plc 2018.
Registered ofce: 81 Newgate Street, London EC1A 7AJ Registered in England No: 1800000. Produced by Openreach. Designed by westhill.co.uk
PHME 77439
